Building the Future of First Responder Training at the MAAC

We are thrilled to announce an expansion to the MAAC Foundation First Responder Training Campus in the form of a large, dual-purpose building: a new two-story MAAC HQ and an adjoined one-story K9/first responder training building, Kathryn Hall. Kathryn Hall honors Kathryn McMillan, whose generous donation has made this additional training space possible. This innovative development will address our current space limitations and strengthen our commitment to supporting first responders.

The new MAAC Headquarters, made possible by the generosity of the Dean and Barbara White Family Foundation, will feature more classrooms and skill-training rooms to support firefighters, EMS professionals, and law enforcement officers as well as additional expanded office space to accommodate its growing team and partnerships. These enhancements will allow the MAAC to host more courses, workshops, and practical simulations that strengthen responder readiness and interagency collaboration.

First and Second Story Plans for MAAC HQ & Kathryn Hall

MAAC HQ

The new MAAC Foundation Headquarters marks a major step forward in our mission to provide world-class training and support for first responders. This two-story facility will serve as the central hub of our growing campus, designed to foster collaboration, expand educational opportunities, and strengthen our ability to serve the responder community.

Funded through the generosity of the Dean and Barbara White Family Foundation, the new HQ features dedicated EMT training spaces on the second floor, including skill rooms, simulation areas, and classrooms built to support the next generation of emergency medical professionals. This investment supports not only the physical expansion of our campus but also the growth of our team and the development of new programs and training opportunities.

The first floor houses additional classrooms and training rooms for firefighters, law enforcement, and all first responder disciplines, as well as expanded office and conference spaces for our growing team and partners. Together, these additions will enable the MAAC to host more courses, hands-on workshops, and training exercises that prepare responders for real-world challenges.

With this expansion, the MAAC Foundation continues to invest in training that saves lives, creating a space where knowledge, experience, and innovation come together to strengthen public safety across Northwest Indiana and beyond.

Kathryn Hall

Kathryn Hall will serve as a dedicated indoor K9 training facility designed to allow handlers to have a training space regardless of weather conditions.

Made possible through the generosity of Kathryn McMillan, this one-story building adjoins the new MAAC Headquarters and provides a flexible, climate-controlled space where first responders can train year-round. Inside, K9 teams will find specialized training areas, helping prepare dogs and handlers for search and rescue, detection, and law enforcement operations.

Kathryn Hall includes a fully equipped dog wash station, a garage and parking area for officers transporting K9 units, and multi-purpose classrooms that can be used by any responder discipline. These features create an environment that is both practical and humane, offering safe, efficient, and realistic training scenarios that enhance teamwork and performance.

Together with the new MAAC Headquarters, Kathryn Hall reflects our continued mission to provide cutting-edge, collaborative training opportunities for those who serve our communities with courage and dedication.

Current Progress

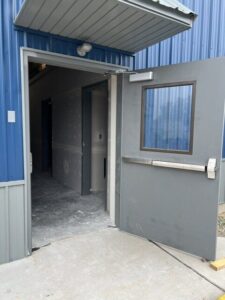

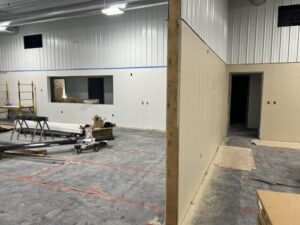

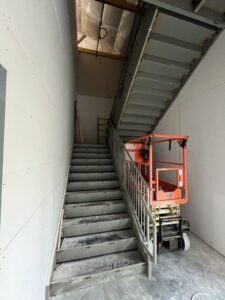

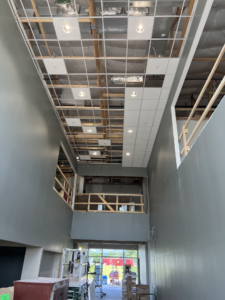

November 6th, 2025 Groundbreaking Photos

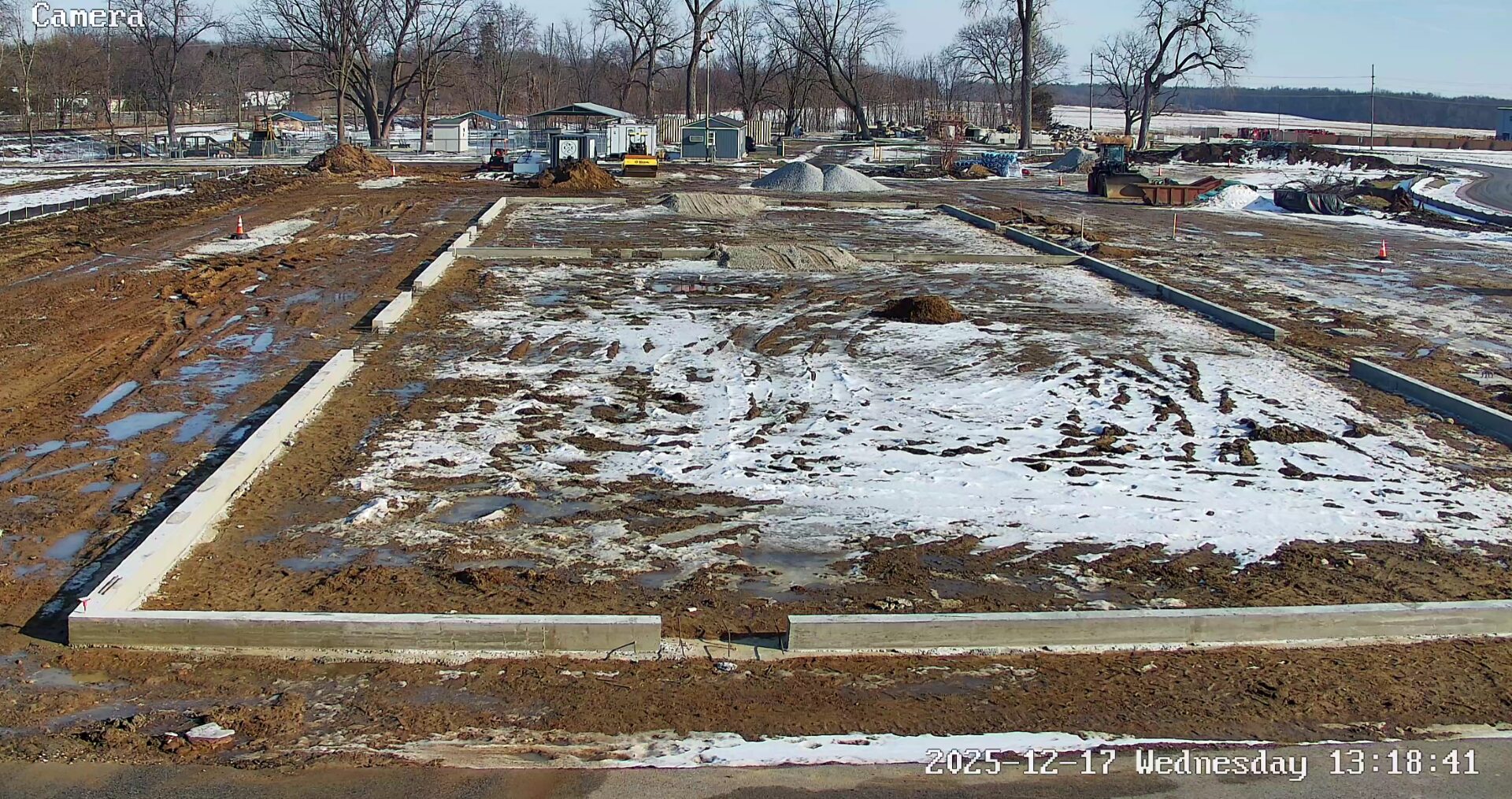

The MAAC Foundation will build a new headquarters and expand its training campus in Valparaiso.
2026-06-06
2026-06-01
2026-05-22
2026-05-16
2026-05-09
2026-04-30
2019-01-01
2026-04-20

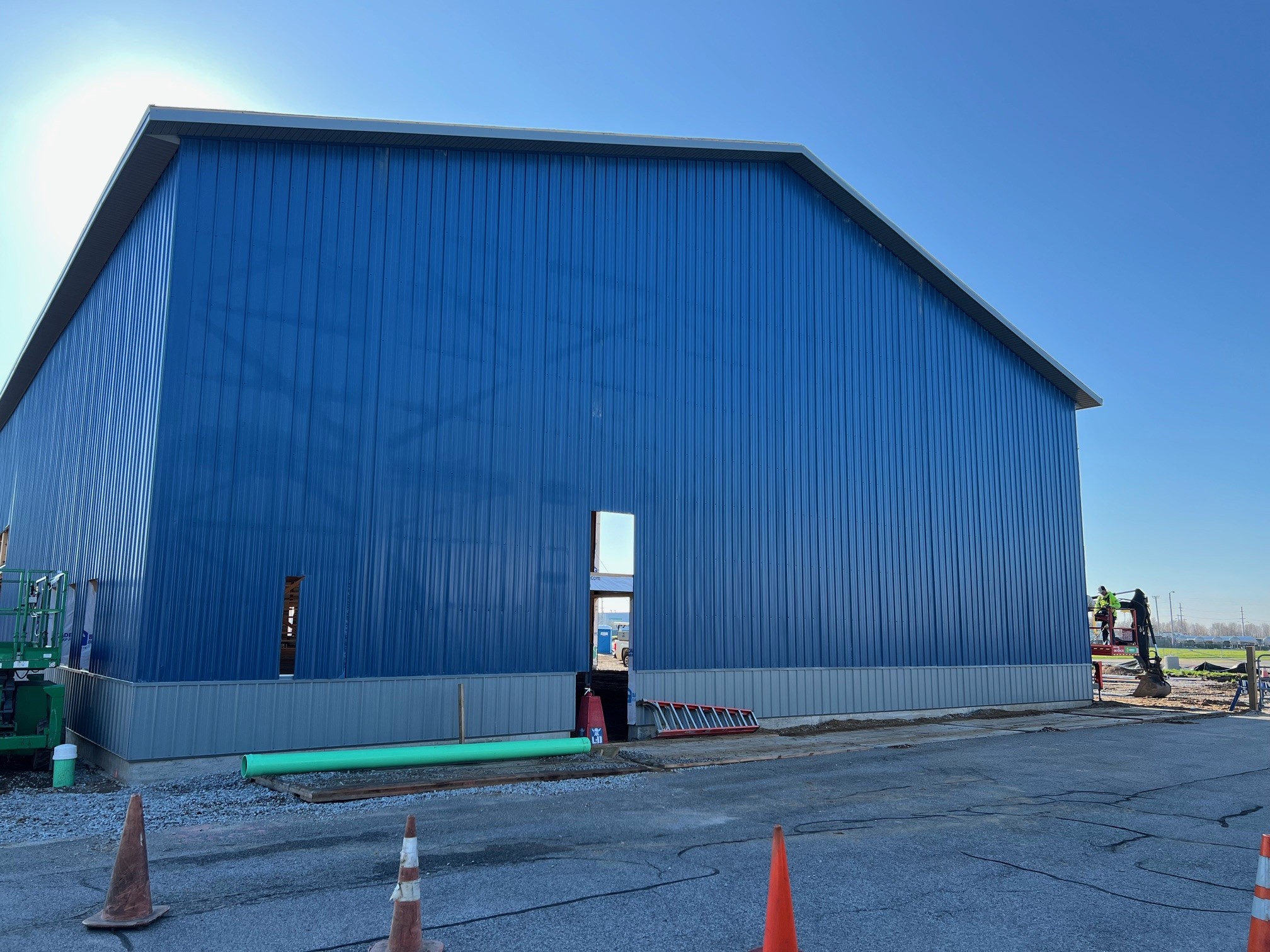

2026-04-17
2026-04-11
2026-04-11
2026-04-03
2026-03-27
2026-03-20
2026-03-13
2026-03-05
2026-02-27
2026-02-20
2026-02-14
2026-02-13
2026-01-30
2026-02-05
2026-01-22
2025-01-15
2026-01-09
2025-12-17
2025-12-12
2025-12-02
2025-11-12

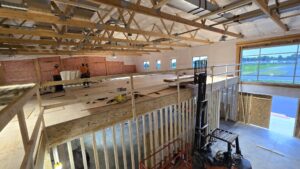

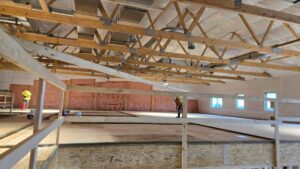

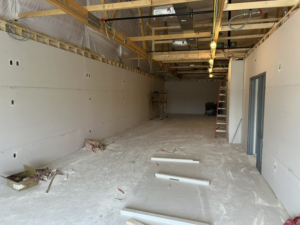

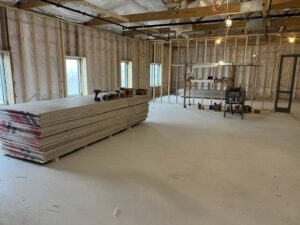

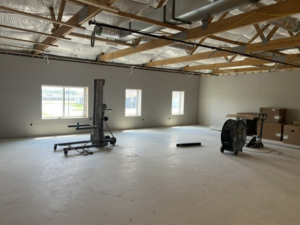

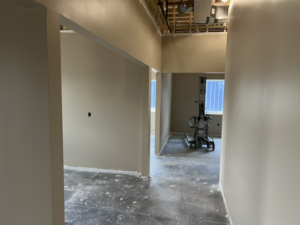

Week 30

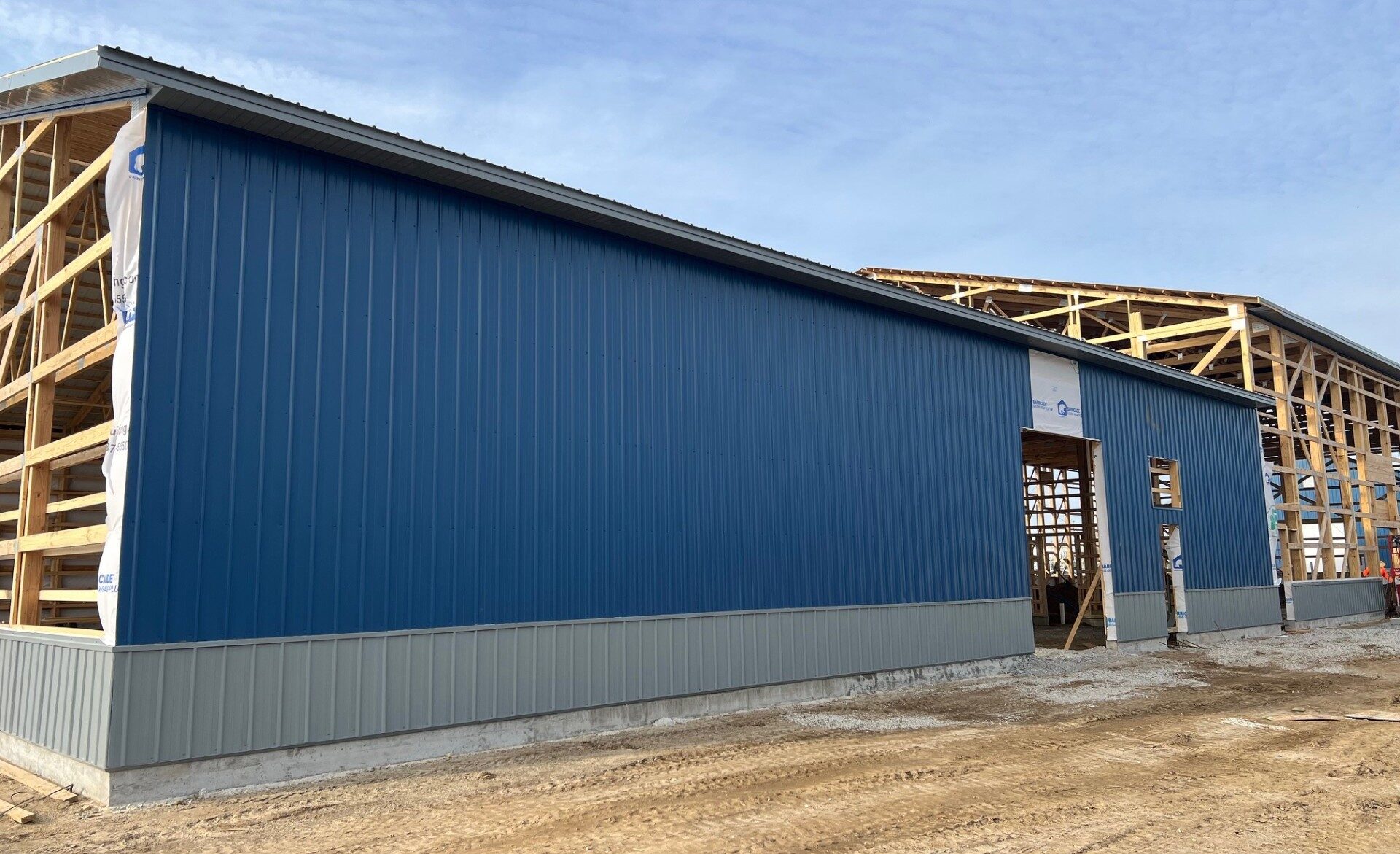

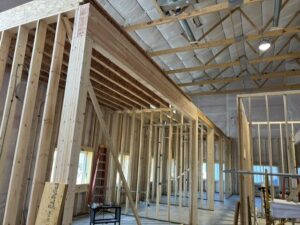

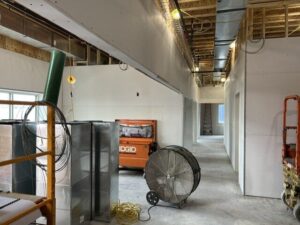

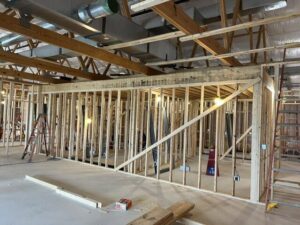

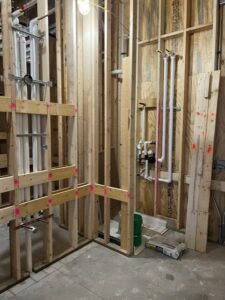

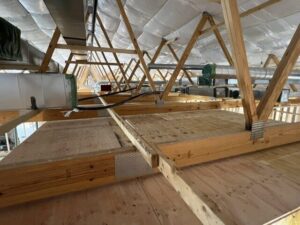

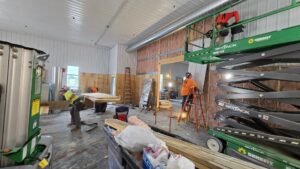

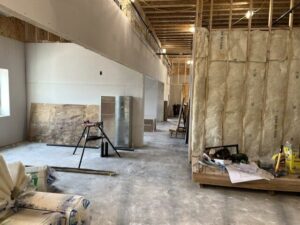

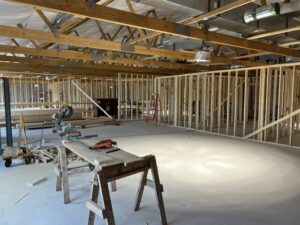

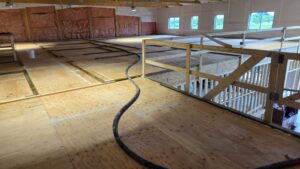

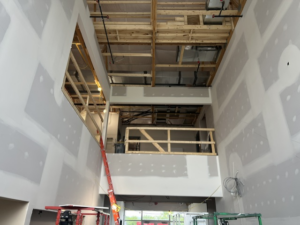

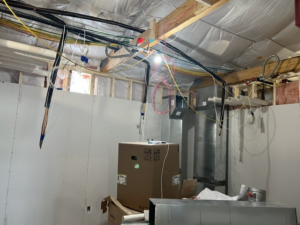

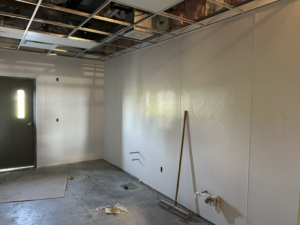

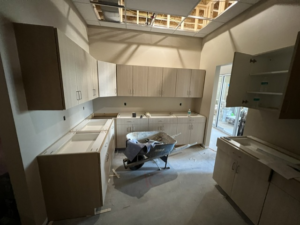

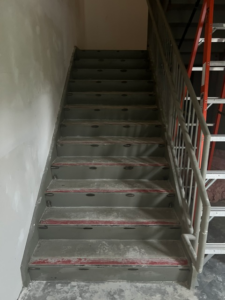

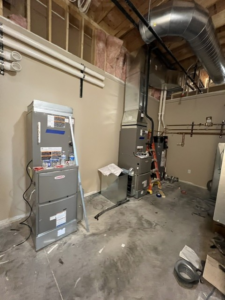

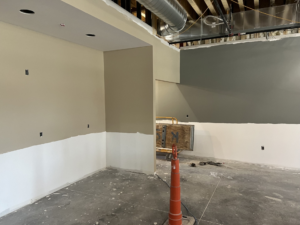

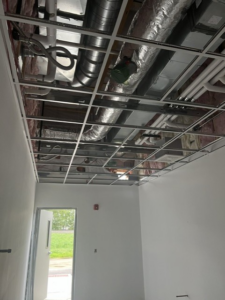

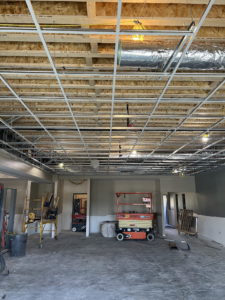

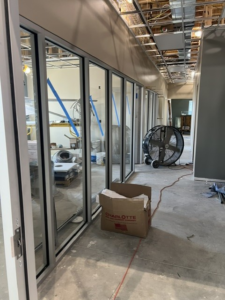

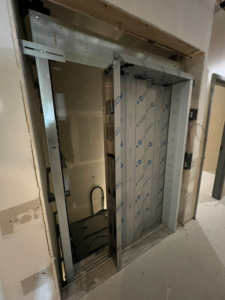

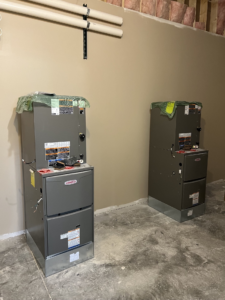

The Carpenters are continuing with the installation of the walls and have also started working on the floor joist over the office area and breakroom.

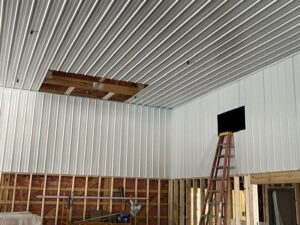

Cleary is working on the getting the metal ceilings and walls in the K9 side.

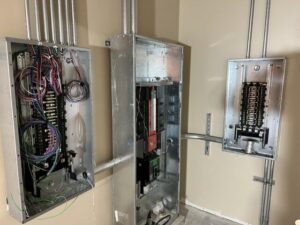

Kleckner has returned to start working on the installation of the dry wall and will be also installing the interior wall insulation.
Circle R continues to follow the carpenters and at times are working side by side.

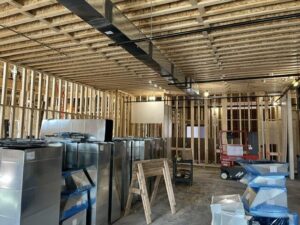

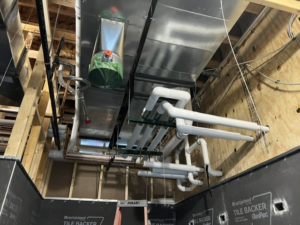

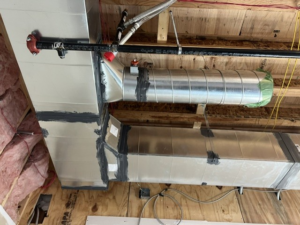

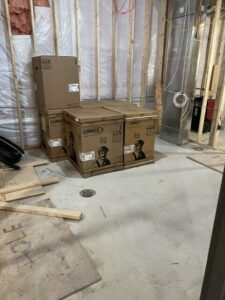

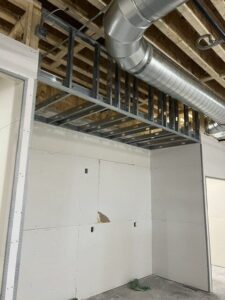

Bloomfield continues to work on the ductwork and has shifted back to the K9 Rooms as the metal wall siding has gone in.

Valley Fire has the majority of the sprinkler pipe installed on the K9 side.

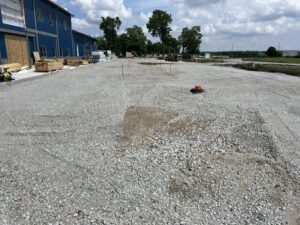

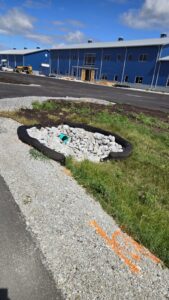

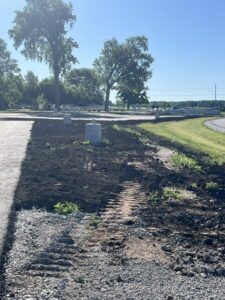

ECE and Olson have completed most of the parking lot with a little more fine grading to occur before the asphalt binder next week.

Week 29

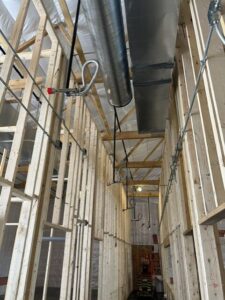

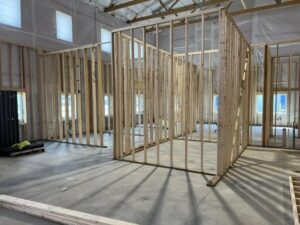

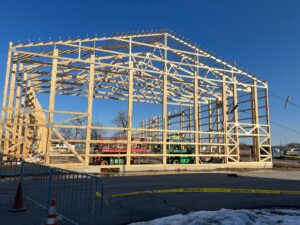

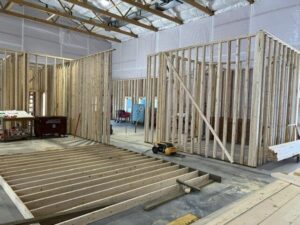

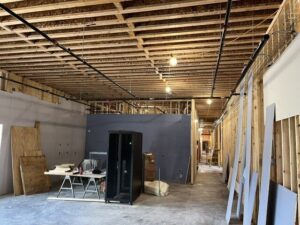

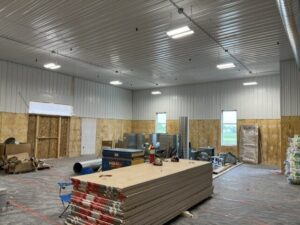

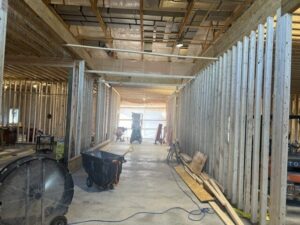

Carpenters continued to frame out HQ with a large amount of the Office Area, break room and bathrooms completed.

Circle R Electricians are chasing the Carpenters and as walls go up the electrical is installed.

Bloomfield continues to install ductwork in the rafters of the two-story area.  They have finished the plumbing on the K9 side.

The last of the concrete work has been completed with the bollards on the north side being poured.

Valley Fire continues to install the sprinkler piping on the K9 side.
Cleary returned to finish out a couple of door and window frames.

L&D started clearing the parking areas for the return of ECE next week to finish the grading and fill to allow for the laying of the asphalt binder across all roads and parking lots.

Week 28

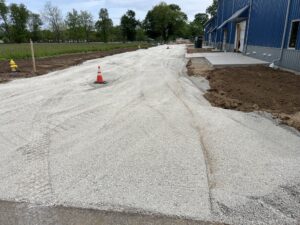

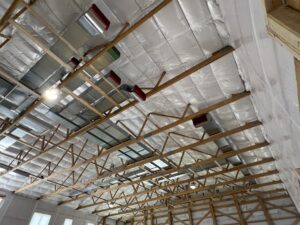

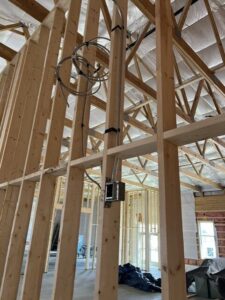

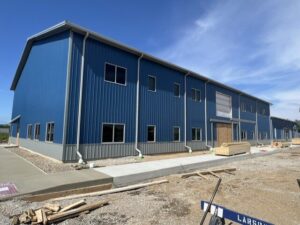

Trout has started to install the upper windows and the entrance doors to the K9 Area.

Bloomfield continues to install ductwork in the rafters of the two-story area.  They have also started to install the plumbing on the K9 side.

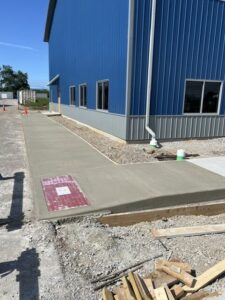

L&D concrete crews completed the West and East sides along with the sidewalk that leads to the K9 Area.

L&D Carpenters are moving forward with walls on the first floor of the HQ building.

Circle R continues to install the wiring in the K9 area.  They have also completed the concrete pole bases for the parking lots.

ECE has started cleaning up the areas to be landscaped and will be working on the road on the North side of the building.
Valley Fire has also started hanging sprinkle piping on the K9 side.

Allied Door delivered the door frames for the interior first floor.

Momper is continuing with the wall insulation.

Week 27

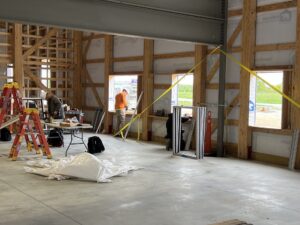

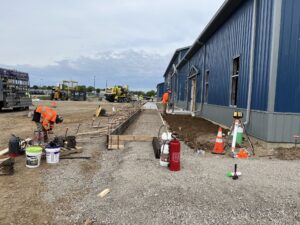

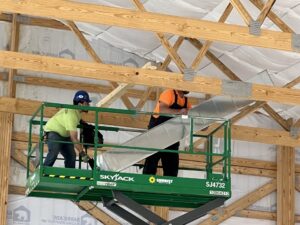

Trout installed some of the first-floor windows, and all the window frames have been delivered.
Kleckner finished the roof insulation.  Momper is continuing with the wall insulation and is behind schedule.

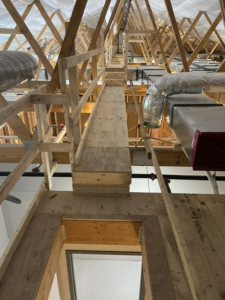

Bllomfiield started hanging ductwork in the rafters of the two-story area.
L&D concrete crews completed the ramps on the North side of the building for each entrance to the building.  They then shifted to the front of the building to start on the sidewalk.  ECE supported this work in digging the footers for the parking lot curbs and laying out the sidewalks to be formed.  ECE has also dug additional footers for the sidewalk to the K9 area and is working on the East and West side sidewalks.
L&D Carpenters essentially have finished the framing on the K9 side and are going to start framing the first floor in the HQ side.
Circle R completed some electrical in the K9 area.  They still need to finish 3 light poles in the parking lot so ECE can start working on the final grading for the landscaping.

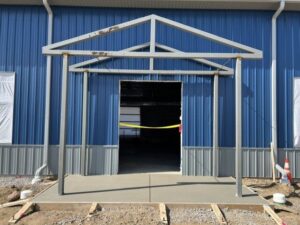

Week 26

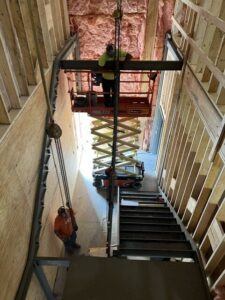

Kleckner continued to install the roof insulation in the K9 area and has moved over to the two-story roof.  They plan on working on Saturday to try and stay ahead of Bloomfield.  The wall insulation has also started in the K9 Area.

Bloomfield started the installation of the duct work in the K9 area along with the Carpenters starting on the framing of walls.

The Iron Workers installed the steel for the front entrances.

Cleary installed the trim around the exterior of the windows.

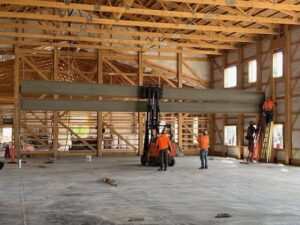

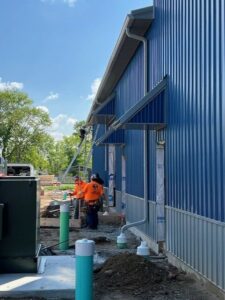

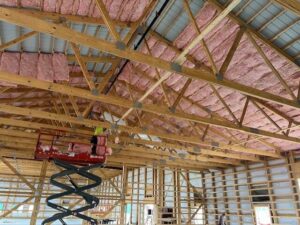

Week 25

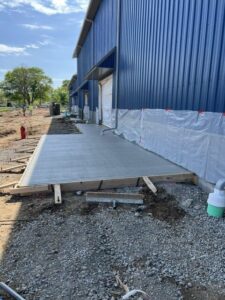

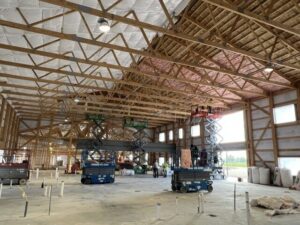

Over the weekend Cleary came in and worked on the overhangs on the North side of the building.  The replacement items have also arrived to finish the corners and replace the damaged sheeting from the wind.

On Monday, Valley started mobilizing to install the sprinkler piping through the peak of the building.  Kleckner also started mobilizing to install the roof insulation.
ECE also dug the footers for all the stoops and garage entry points in the building.  Some of the footers were poured on Wednesday, and the plan is for the rest in the coming week.

Laporte Seamless Gutters installed the gutters today along with the carpenters working on the forms for the stoops.
The Steel Guys installed the beam in the classroom and the one to hold the second floor.

Week 24

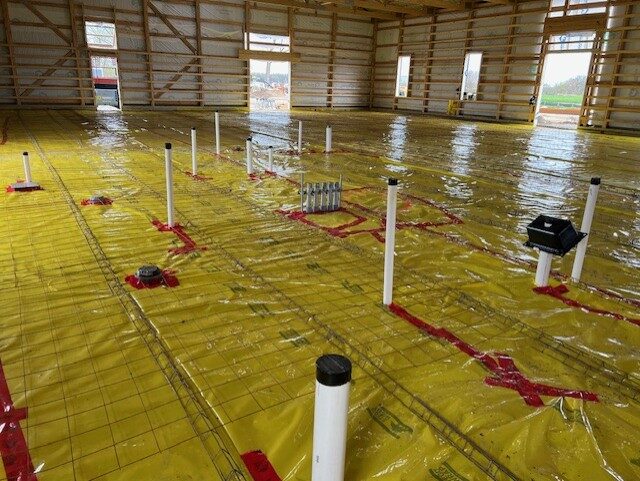

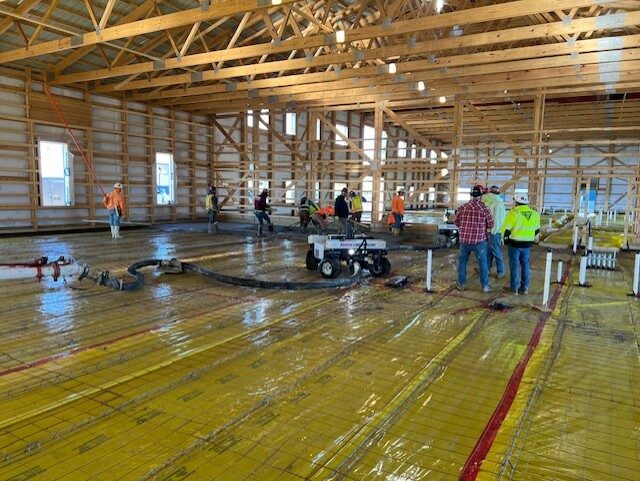

On Monday, the Concrete Crews for L&D poured the floor in the K9 Section and on Wednesday poured the rest of the building.  The concrete finishers did not leave the site until about 10 pm on Wednesday.

Cleary over last weekend came in on Sunday the 19th and finished the roof of the 2 Story.  They continued to work on the ridge caps on the roofs and installed the cupolas. They also continued with work on the outside sheeting and overhangs on the North side of the building.  The additional sheeting arrived to repair the damaged sheeting on the West side from the wind.
NIPSCO came in and connected the Meter on Friday and we now have temporary power inside the building.

Construction Concrete Day

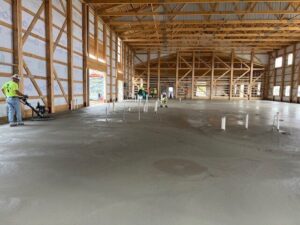

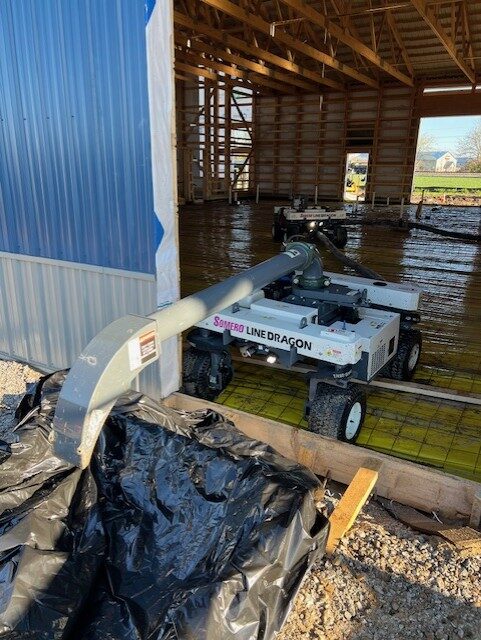

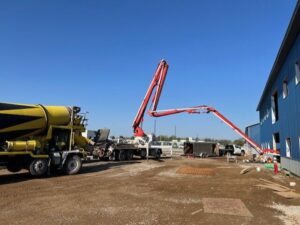

Concrete is being poured on the K9 Side.  The HQ Side is scheduled to be poured on Wednesday.

The robot is pretty cool.

Week 23

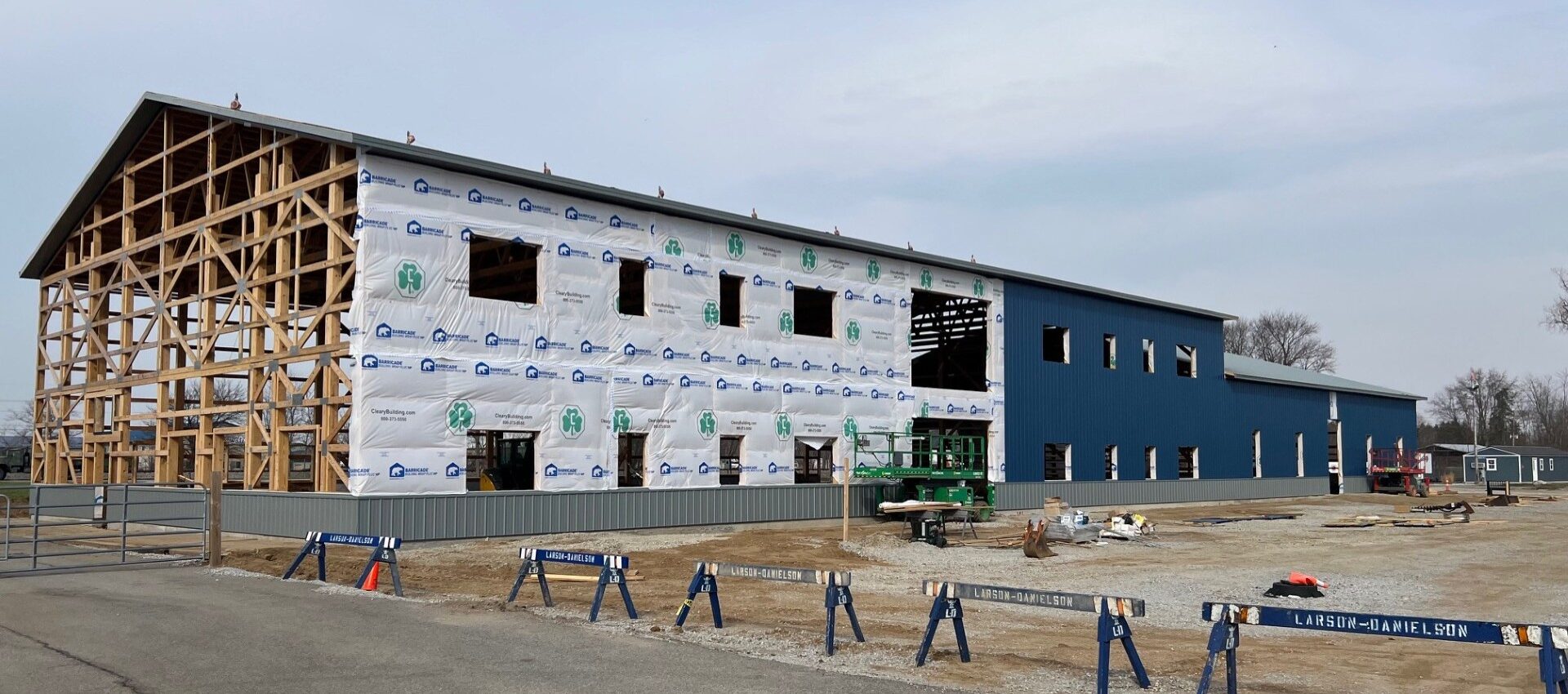

Cleary did not have a good week but was able to recover somewhat on Friday with the finishing of the Metal Roof on the South side of HQ.  They also started clearing excess materials around the perimeter, and they set them temporarily near the K9 area.  On one of the rain days, they did work in the Cleary Shop to build the Cupola's.  They have also started installing some of the overhangs.

ECE returned to work on the downspout drains on the South side of the building.  We have a couple of alignment issues that will be corrected next week.

The L&D concrete crew started laying down the vapor barrier and placing wire mesh throughout the building.

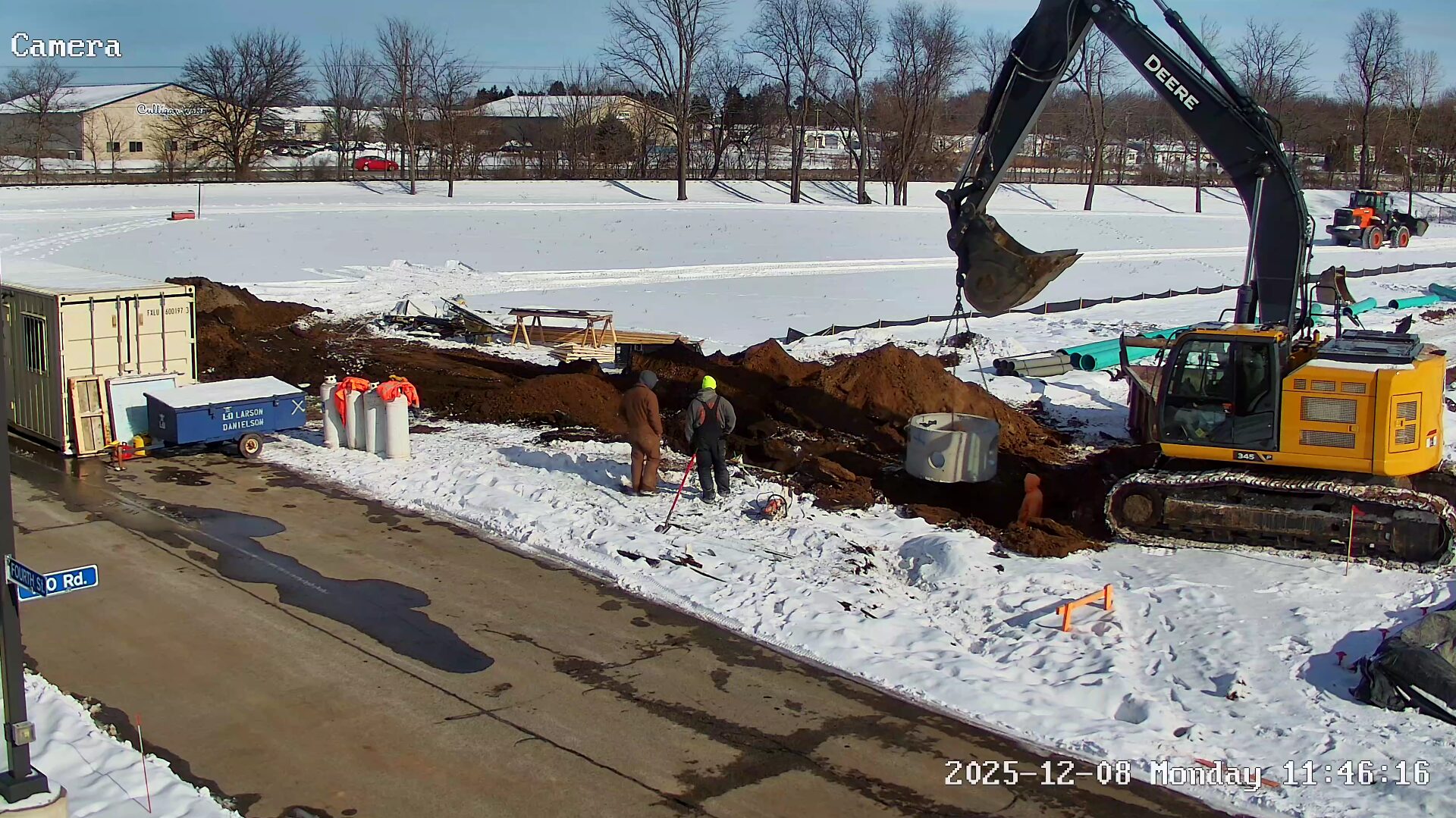

MJ Electric (NIPSCO) connected our temporary power.  We are now waiting on NIPSCO to approve the installation of the Meter and then we should have temporary power in the building by Circle R.

Bloomfield set all the drains at the proper concrete height.  During the inspection walk, one drain was found missing and that was installed.

Circle R set all the floor IT / Electrical outlet boxes that will come up in the center of key rooms to avoid cords running on the floor.

Week 22 Part 2

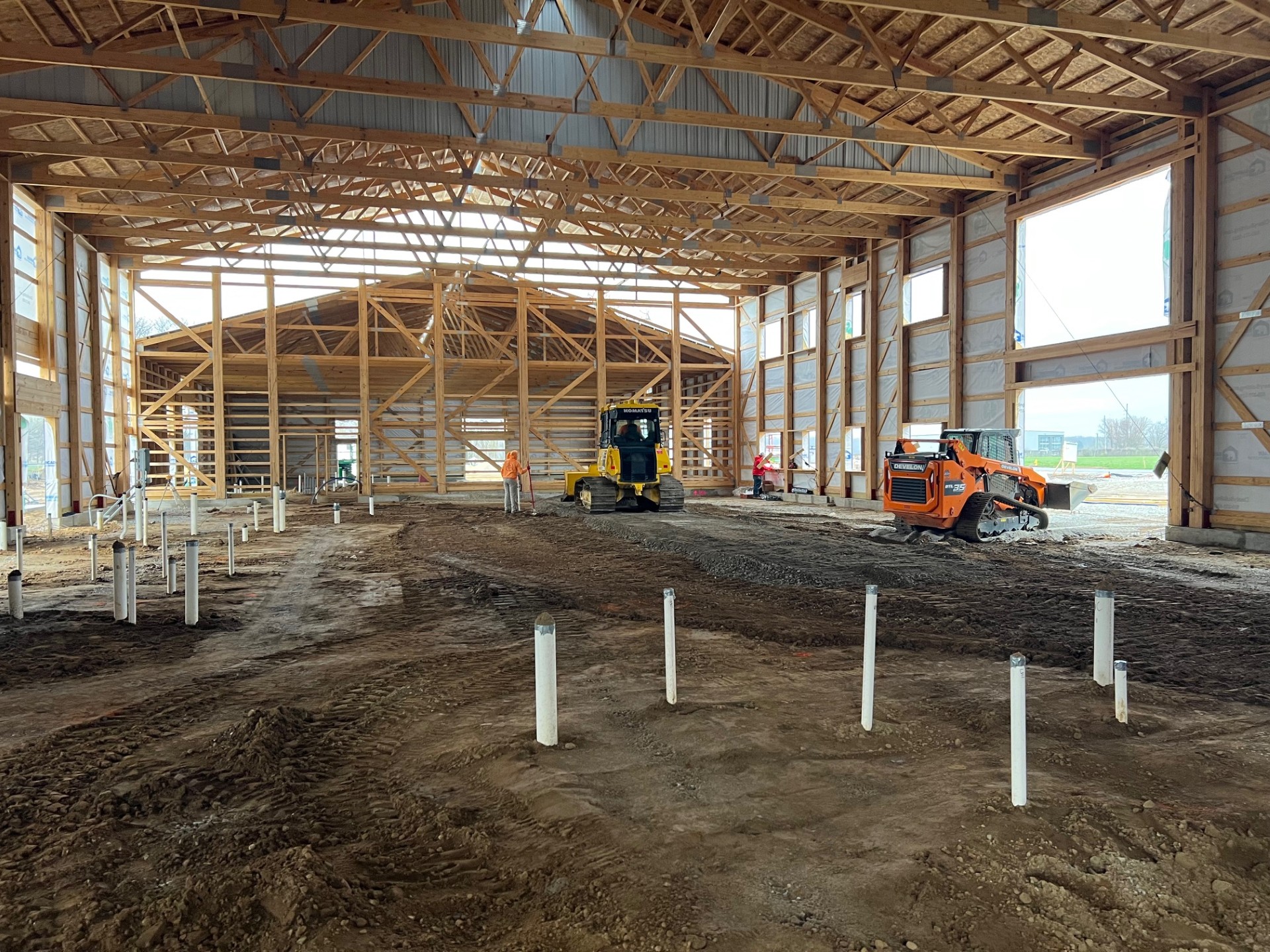

ECE also started compacting and backfilling stone inside the building for the upcoming concrete pour.

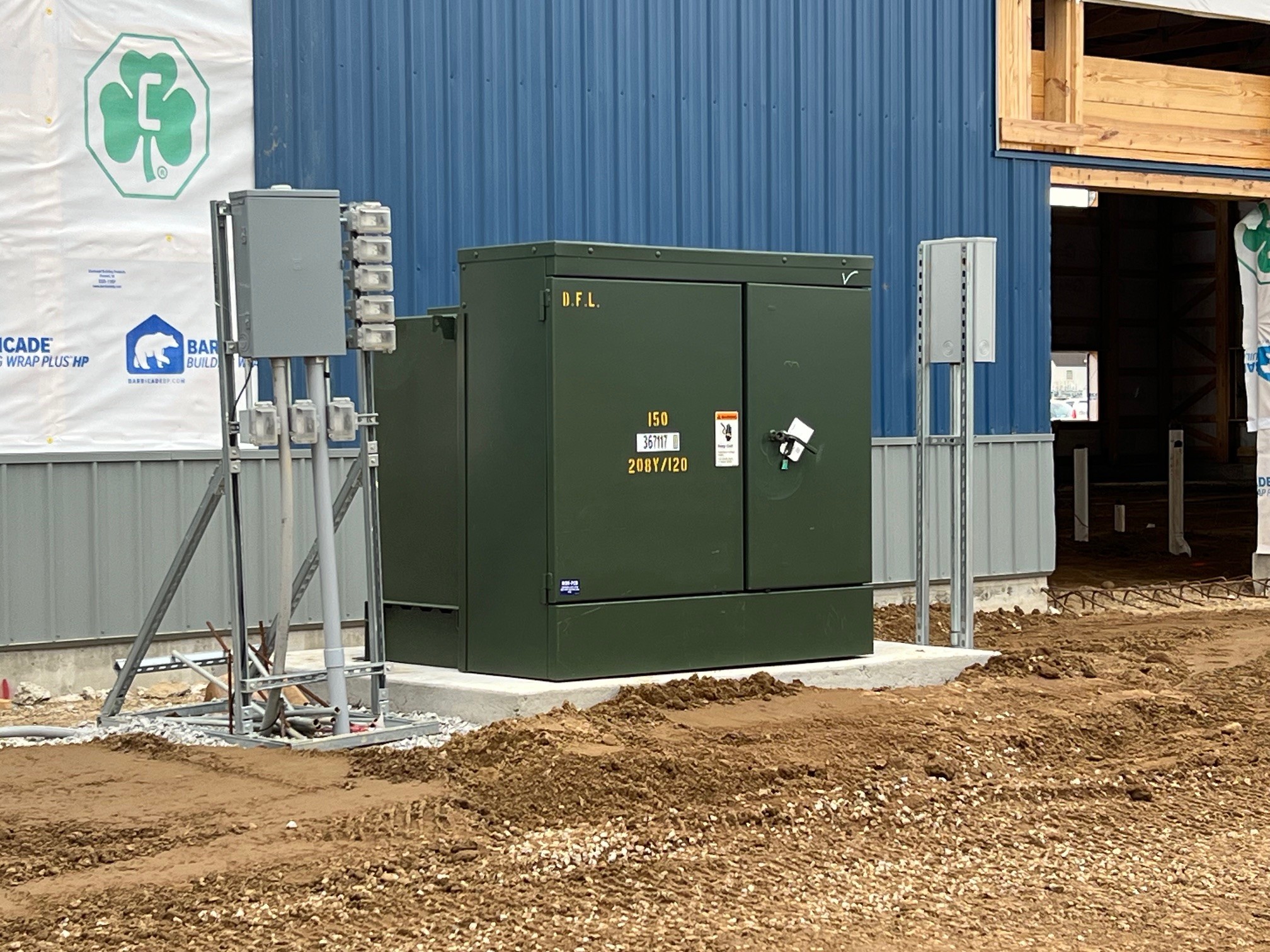

MJ Electric (NIPSCO) set the transformer for HQ. and also pulled the wire to the NIPSCO Box at the street.  Next week they plan on connecting the temporary power.
Bloomfield came back and finished the gas line to the island stove and installed the drain to the K9 training room.

Trout Glass stopped in and verified all the window measurements.

Week 22 Part 1

Cleary installed the Vapor Barriers on both the East and West end of HQ followed by the metal siding.

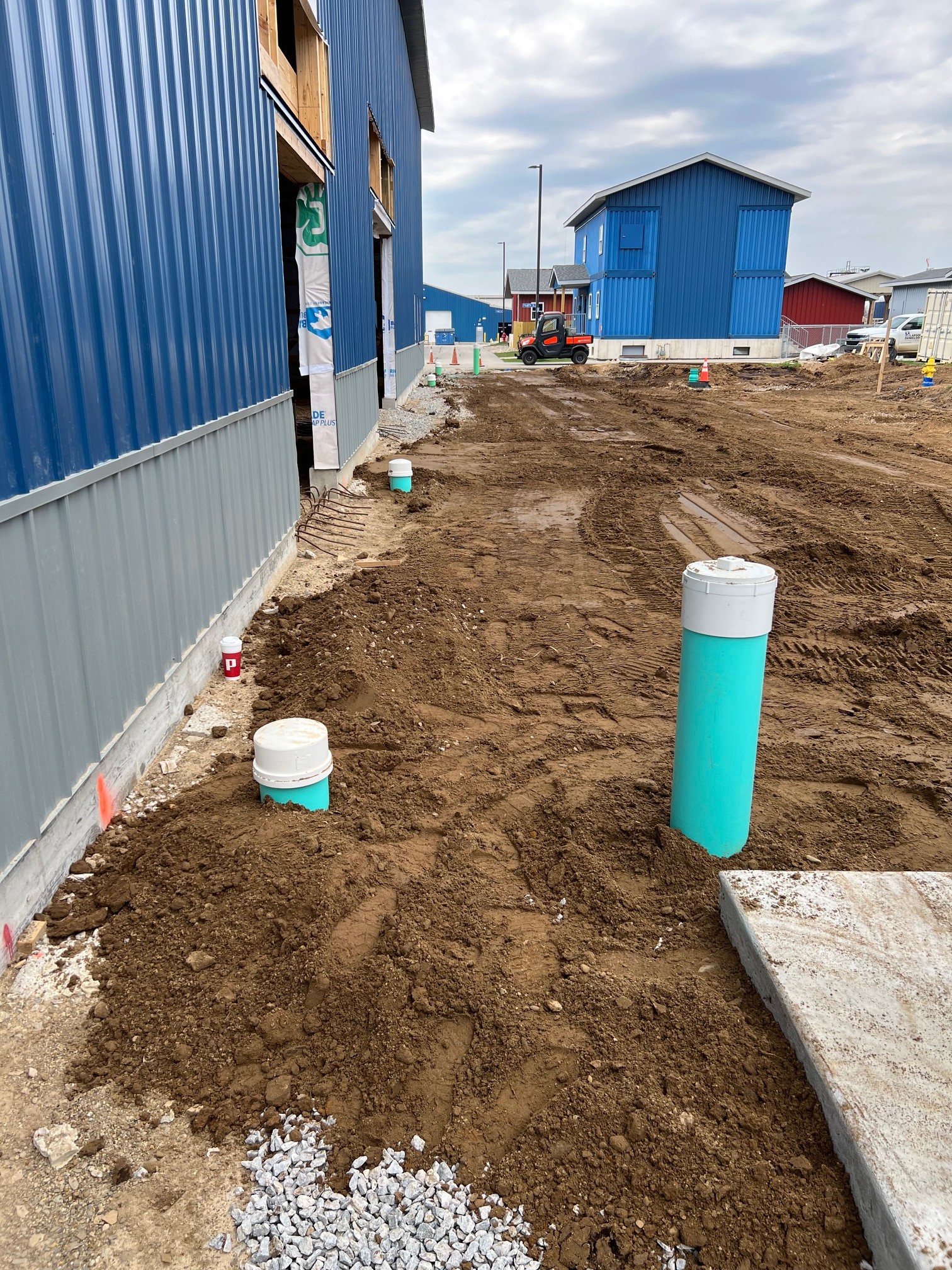

ECE completed the North side gutter underground drains.

Week 21

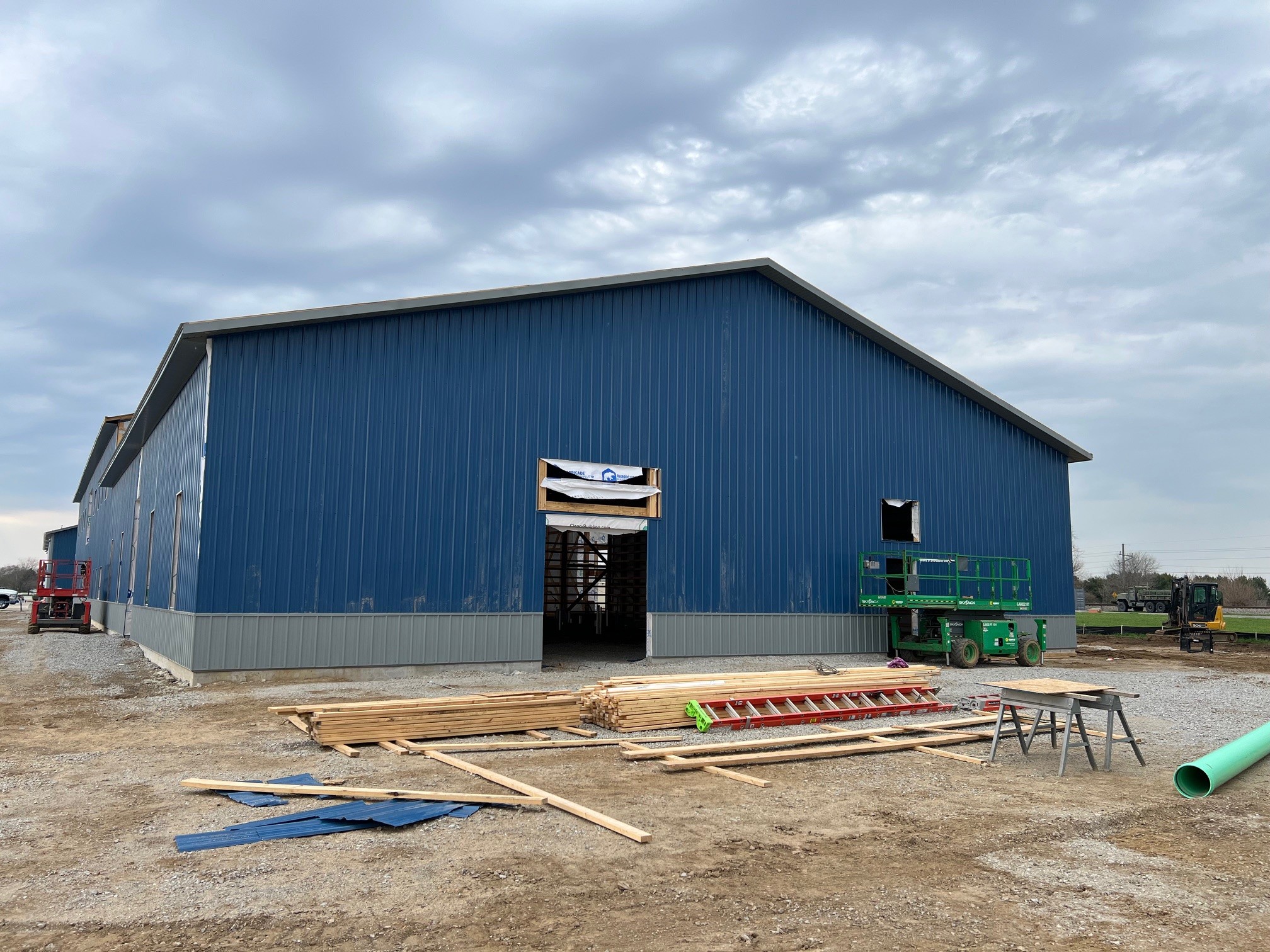

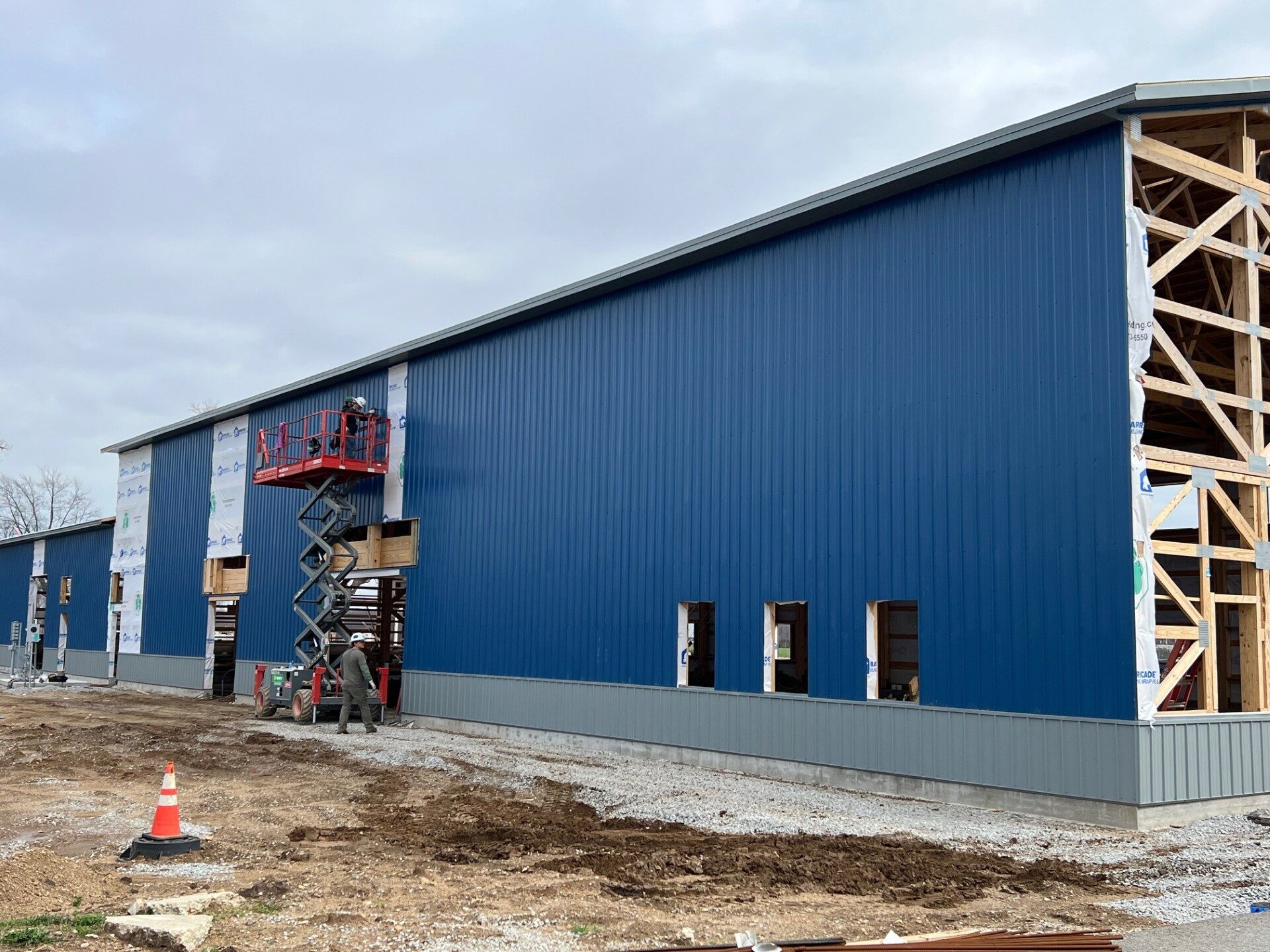

The wind and rain played havoc with putting up the metal walls this week.

The crews worked last Saturday and were able to get the sheeting on the 2-story section.  The rest of the windows were cut in later in the week.
On Friday, the weather improved, and the crews started on the North wall of the 2-story section.

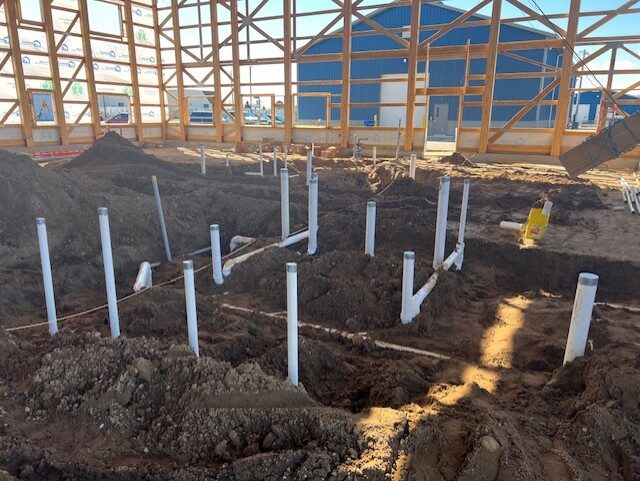

Bloomfield finished the underground plumbing in the building.  The plumbing inspection was also completed, and the backfilling of the plumbing below the floor can now proceed.

Week 20

The Vapor Barrier and Siding is going onto the South Side of the Building.
The Siding on the North Side for the K9 Side was also installed.

If you look at the cut outs over the doorways those are for the installation of the overhangs which comes after the siding is installed.
Bloomfield has also started the interior plumbing

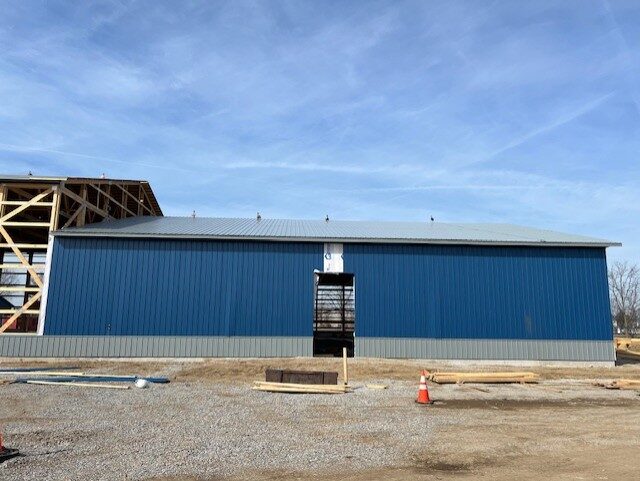

Week 19

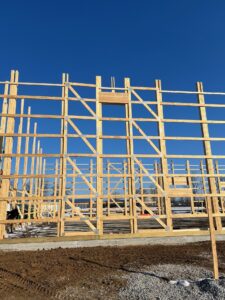

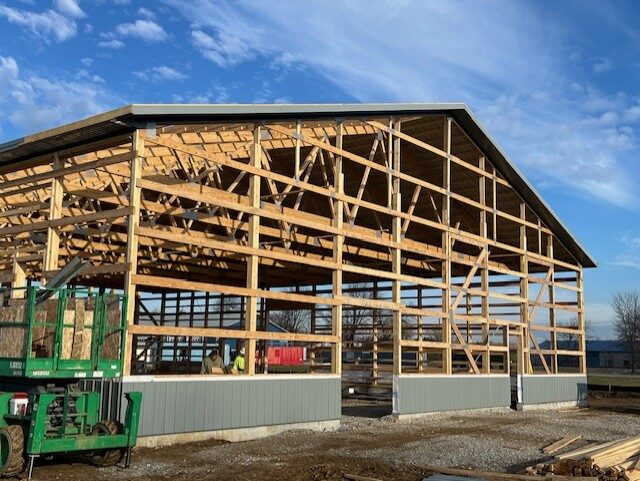

Earlier in the week the Shear Walls were installed on the East and West End of the building.  Lots of blocking fire/smoke stops and finishing around doors and windows.

They also started the bottom grey section around the building.

Week 18

Cleary has started to install the roof sheeting on the 2 story section.
Cleary also continued to install the interior wall supports in the one-story section.

They are hoping to work this weekend due to the two lost days this week due to weather.

Week 17

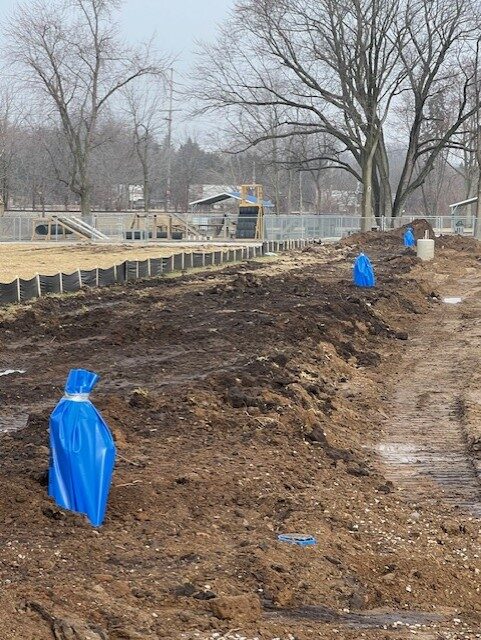

Cleary worked on various smoke blocking along with the soffits.  They did start putting sheeting on the roof.   Cleary plans on working Friday depending on the weather.

ECE finished installing the underground fire water line and installing the three hydrants.  Next step is pressure testing so the hydrants will remain wrapped until then.

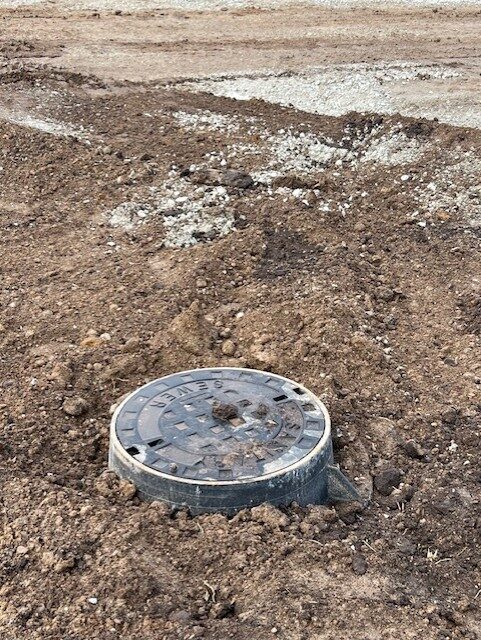

ECE also finished the install of the sewer drop.

Should see Circle R electric back next week to install the last 3 light pole bases.

Week 16

The week seen more activity than the last couple of weeks.

Circle R was back to work on additional light pole bases.

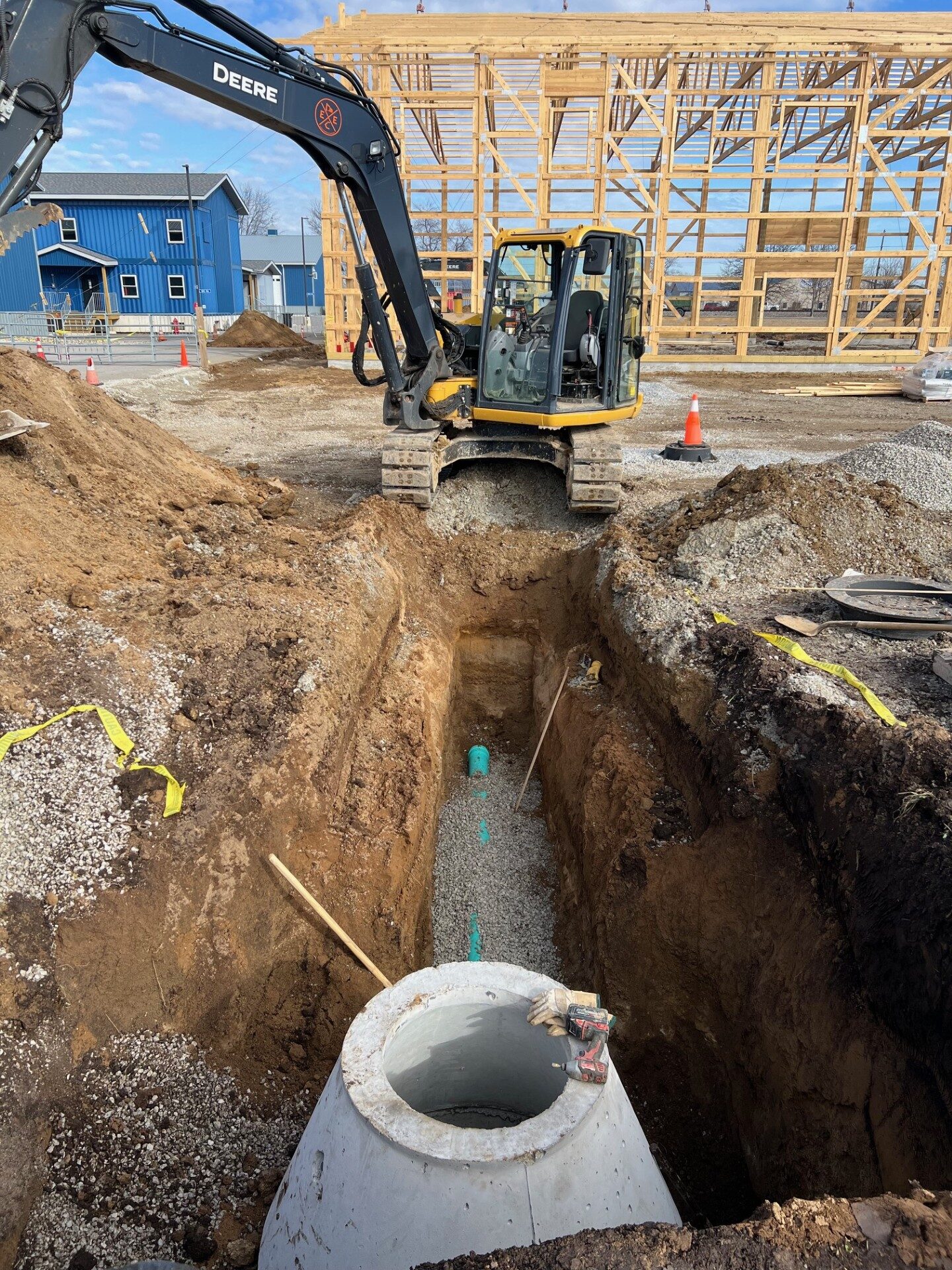

ECE worked with H&G Underground Utilities to connect the domestic water line to the new main on the South side of Montdale and brought the line up inside the building.

ECE and H&G also connected to the Sewer Manhole in front of Heroes Hangout and pulled an 8" sewer line to the new manhole in front of HQ. ECE also tied in to the same manhole and started running the sewer line into the building.

ECE also started working on the Fire Hydrant & Fire Sprinkler Line on the North side of HQ.

Cleary finished the purlins on roof and started to work on the soffits and overhangs on the one story section.

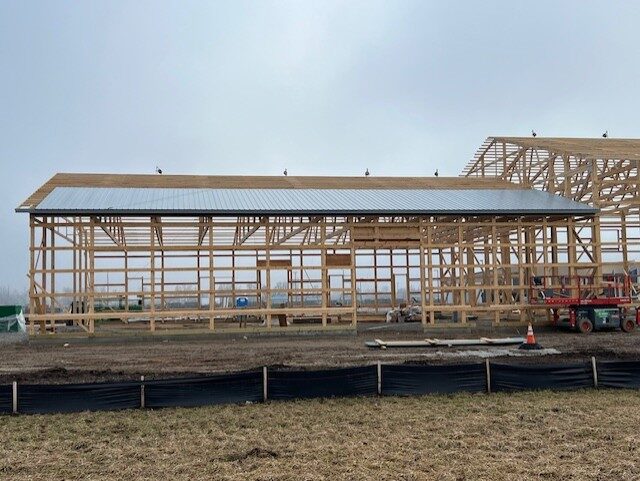

Week 15

With the warmer weather and melting snow, the area turned into a bit of a wet sand pit that slowed the ability of installing the trusses on the one-story portion of the building.  Crews continued to work but switched to work that they could safely get to.  Window frames were started along with additional cross bracing.  The end wall between the 1 and 2 story was installed on Thursday to help strength the movement of the building during the high winds that we saw today.  Additional cabling was also put in place.

Week 14: Part 2

It took a good portion of Friday morning to get the alignment of the building and the end wall set. Multiple cables were placed both inside and outside the frame to hold the building in alignment.  On Friday afternoon an additional 5 trusses were set. On Saturday the crew continued to work and is hoping to set the rest of the trusses on the upper two story part of the building.

Week 14: Part 1

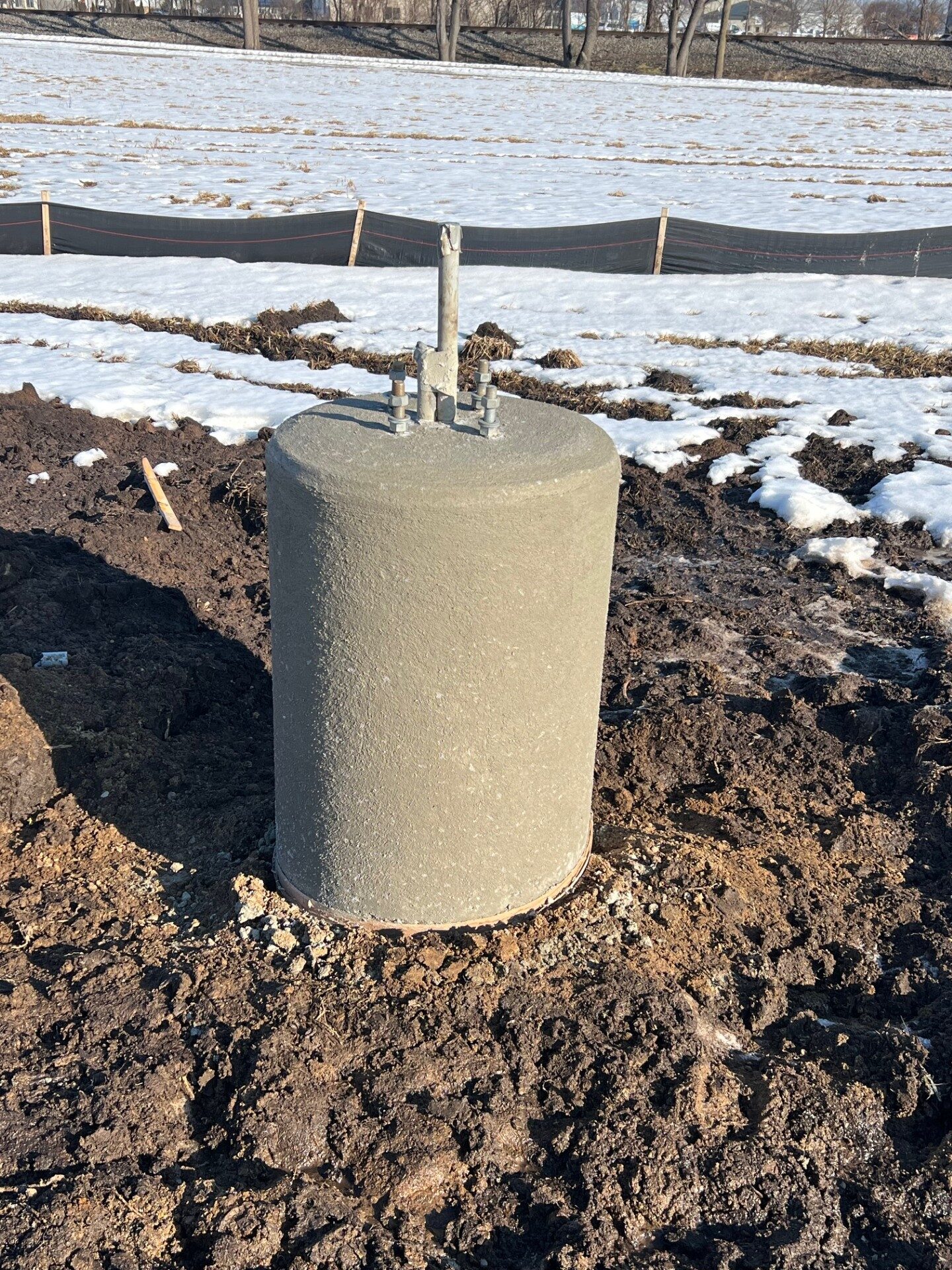

Circle R worked on setting forms for the light poles and poured concrete on Thursday along with the transformer pad.  The Transformer Pad also has the temporary power stand set next to it.

Cleary brought over extra crew for a few days to try and catch up on the lost days due to weather.  Most of the week was spent on installing Shear Walls, Cross Members and Door Headers.

Week 12

The weather has continued to have an impact on the schedule.  Cleary did start Thursday and worked Friday in putting up additional columns on the building. The crews were bundled up pretty well to stay warm.

Week 13

Cleary continued to work this week although a bit slower due to the weather.  Who can blame them.  The majority of the columns are up, and they are now working on the crossmembers.

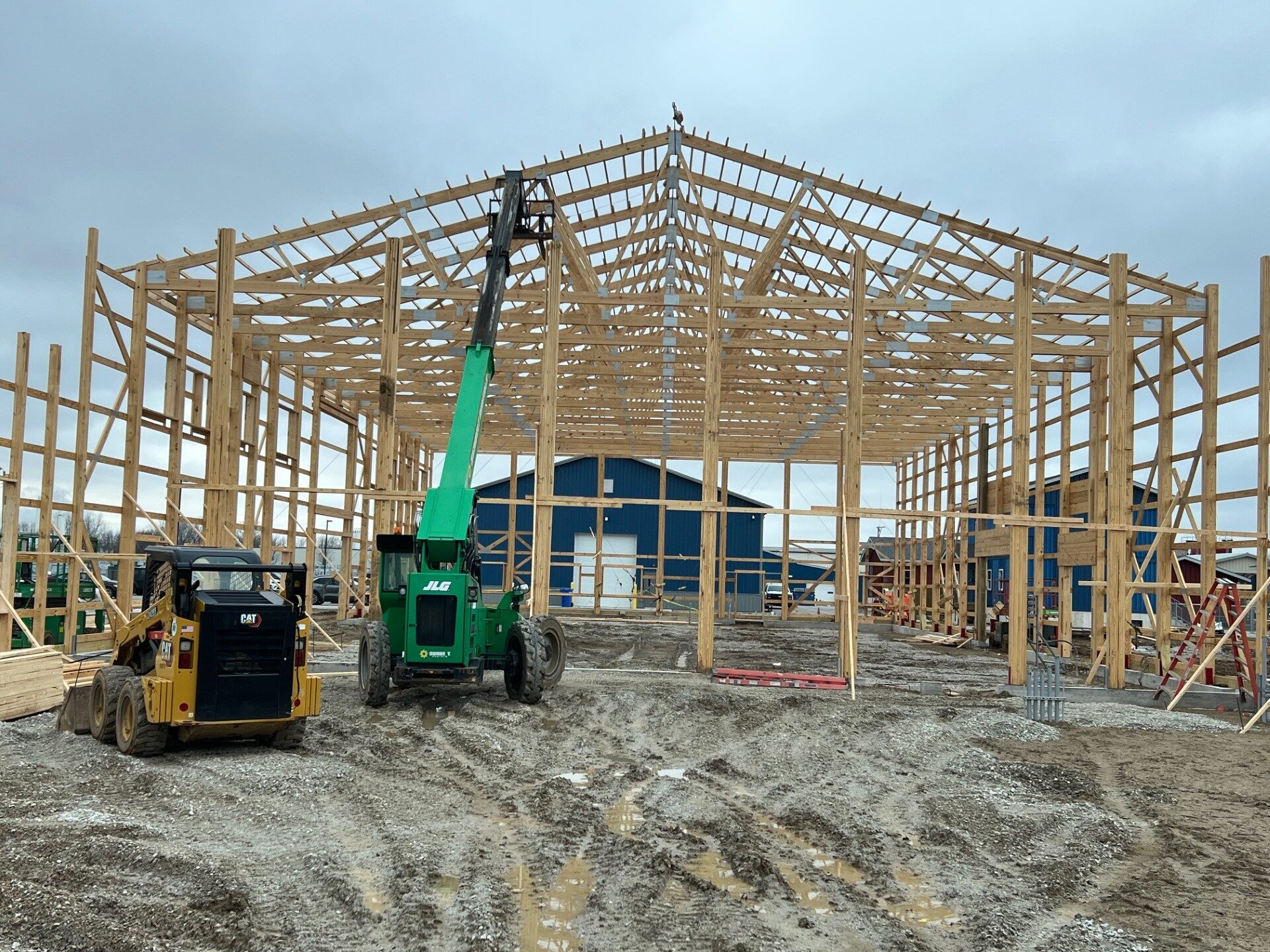

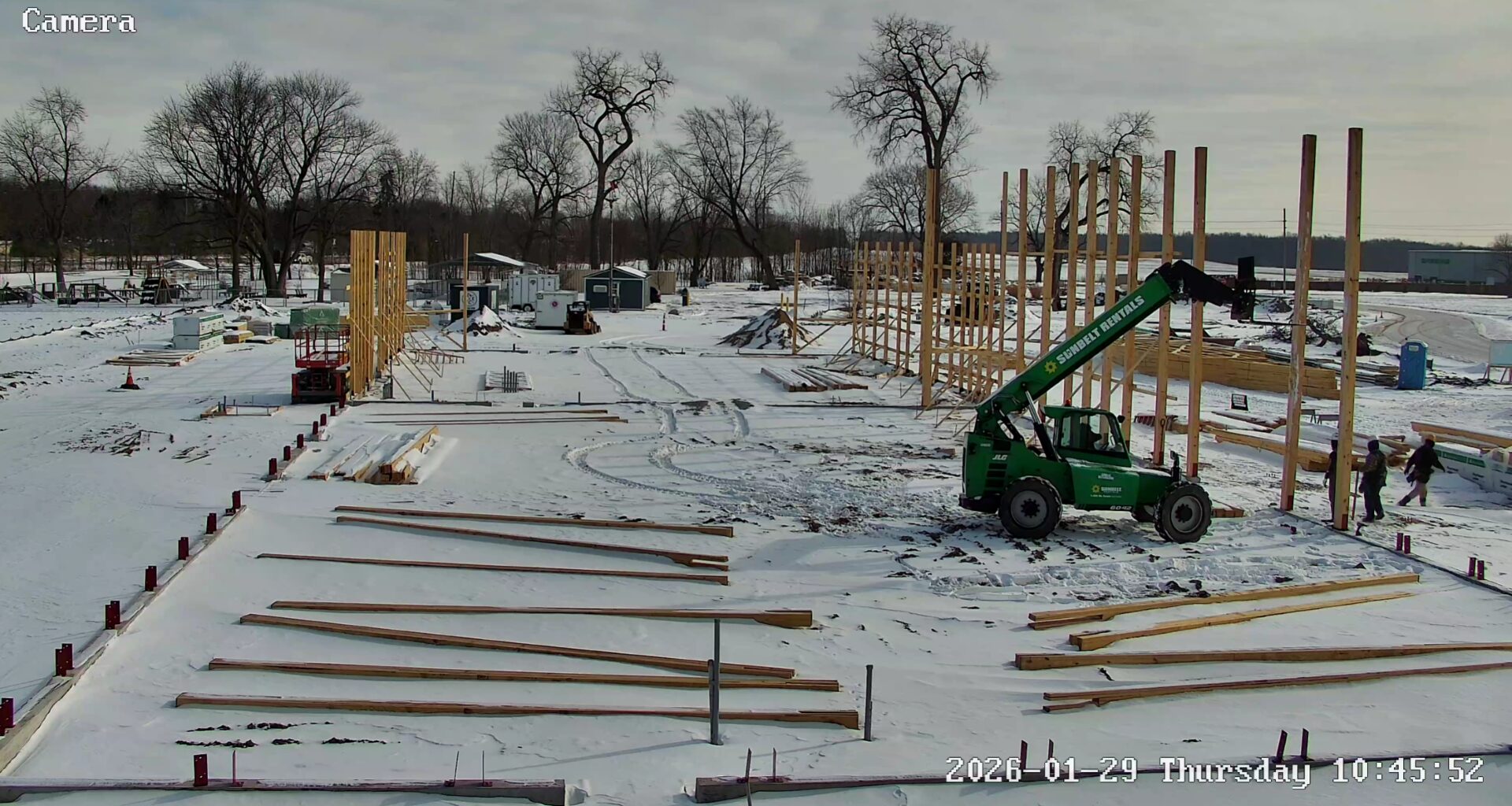

Week 11

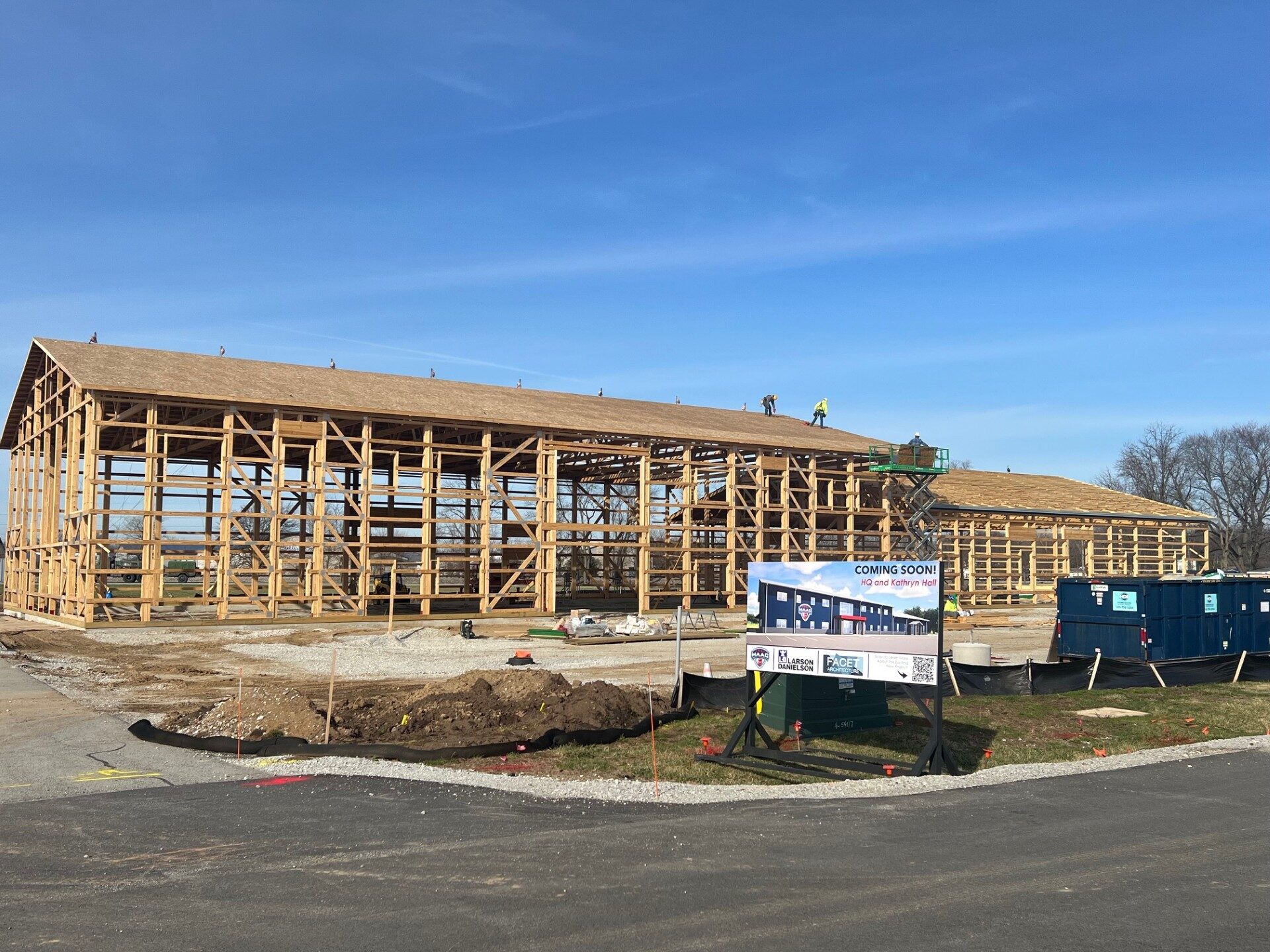

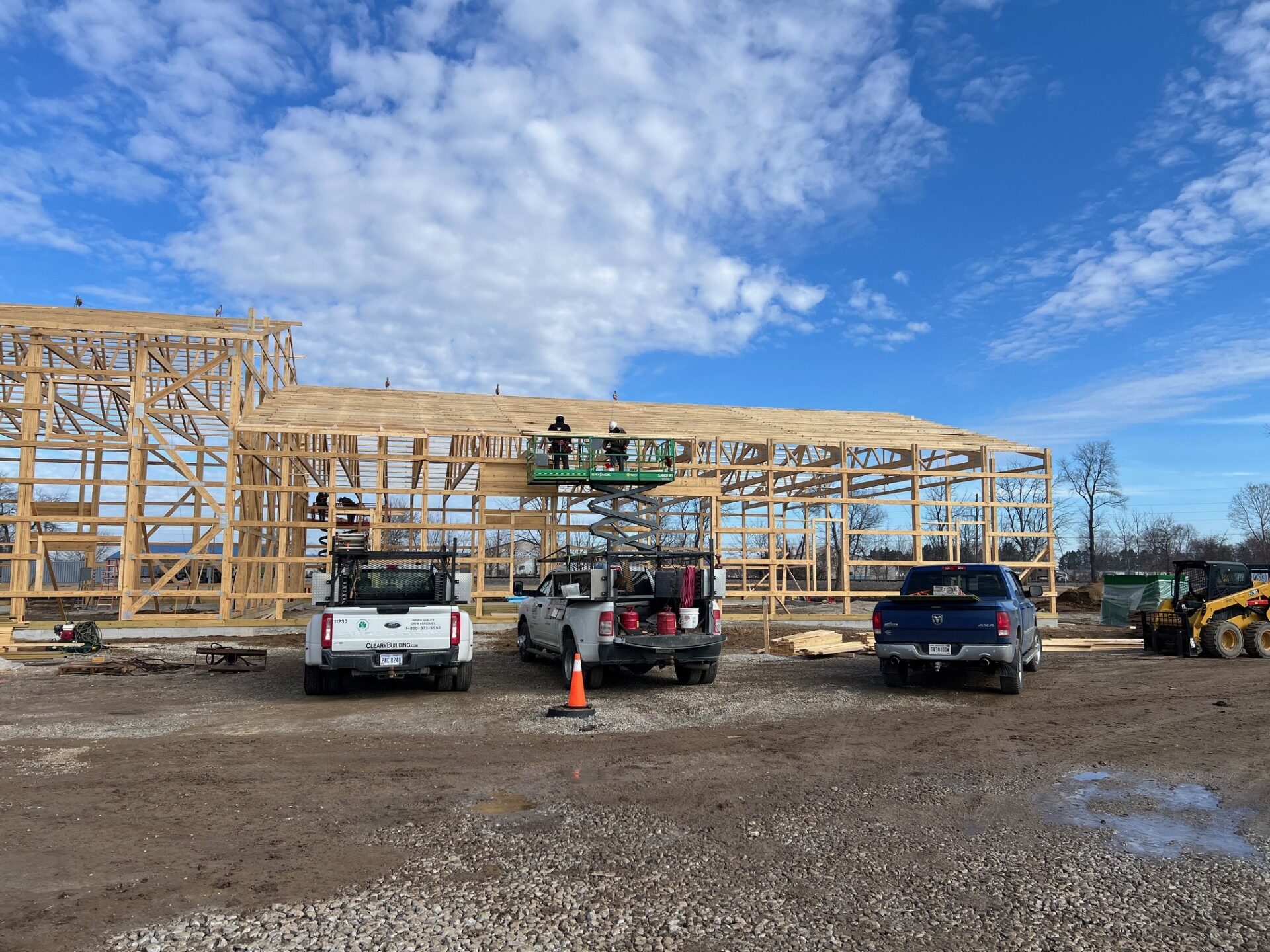

Week 11 of construction and you can start to envision the new MAAC HQ & Kathryn Hall! The weather hasn't been very cooperative but construction continues apace and we should see a fully framed building by mid-February and metal siding and roof in place by mid-March!

Week 10

The week started out well on Monday with Cleary crews arriving on site and moving materials around to get organized and start setting column brackets on the foundation wall.  On Tuesday Cleary finished installing the column brackets and started setting posts on the East side of the building.  Crews did not work on Wednesday or Thursday due to the weather, but additional materials were delivered by Cleary.

Week 9

Over the Holidays not to much went on as far as construction.  Some odds and ends and a bit of housekeeping.  Cleary did deliver the first of many loads of lumber.

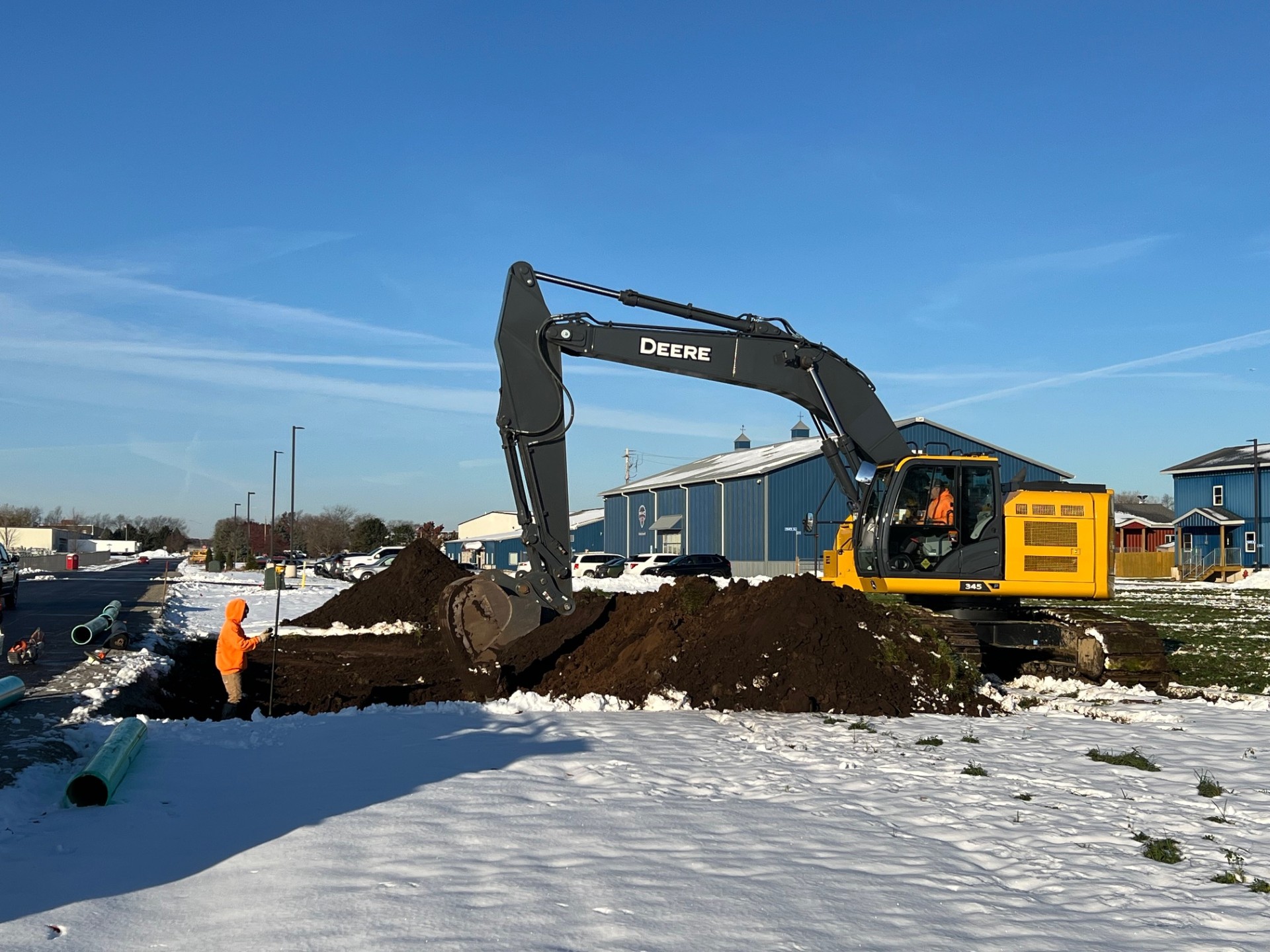

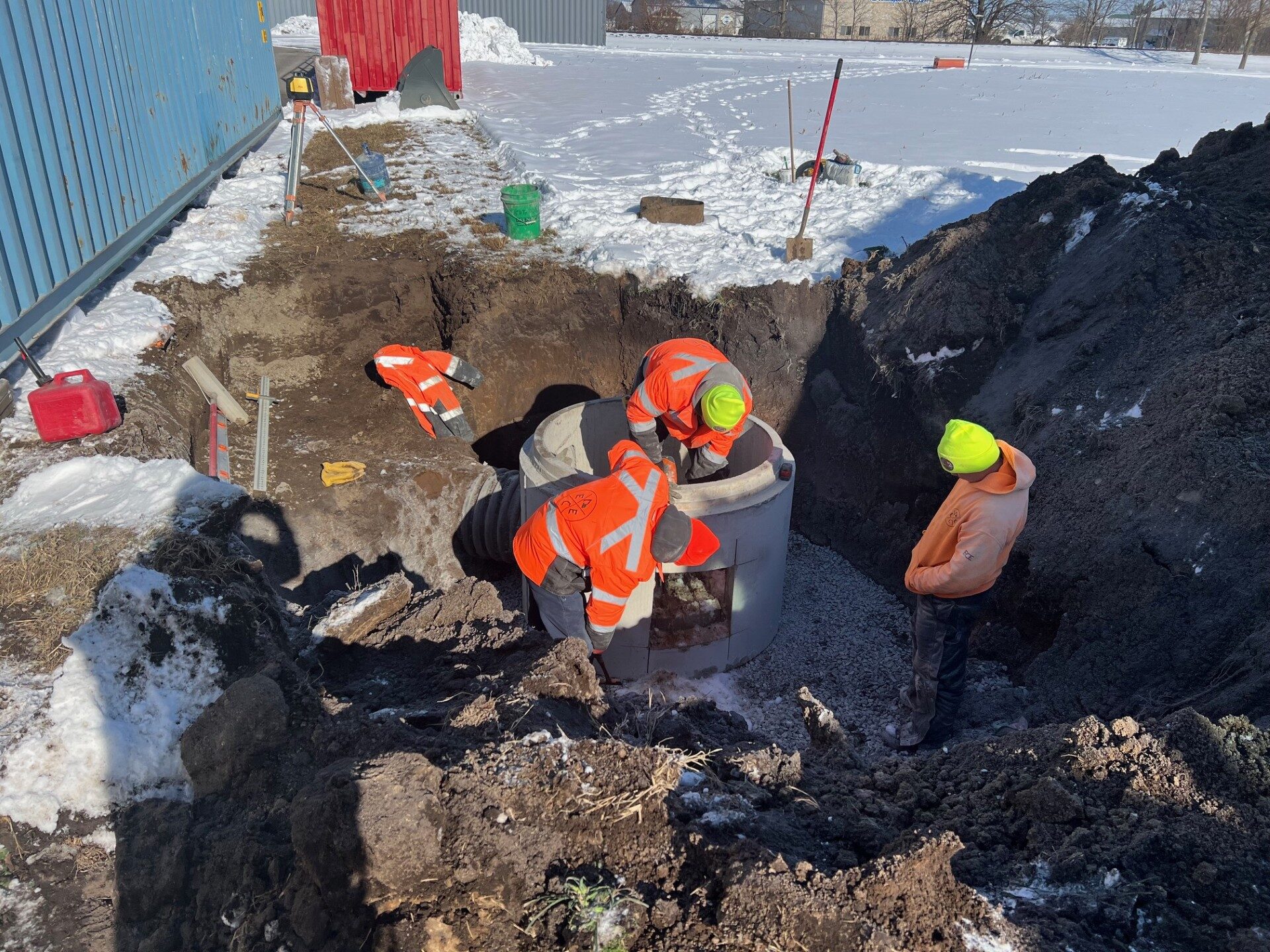

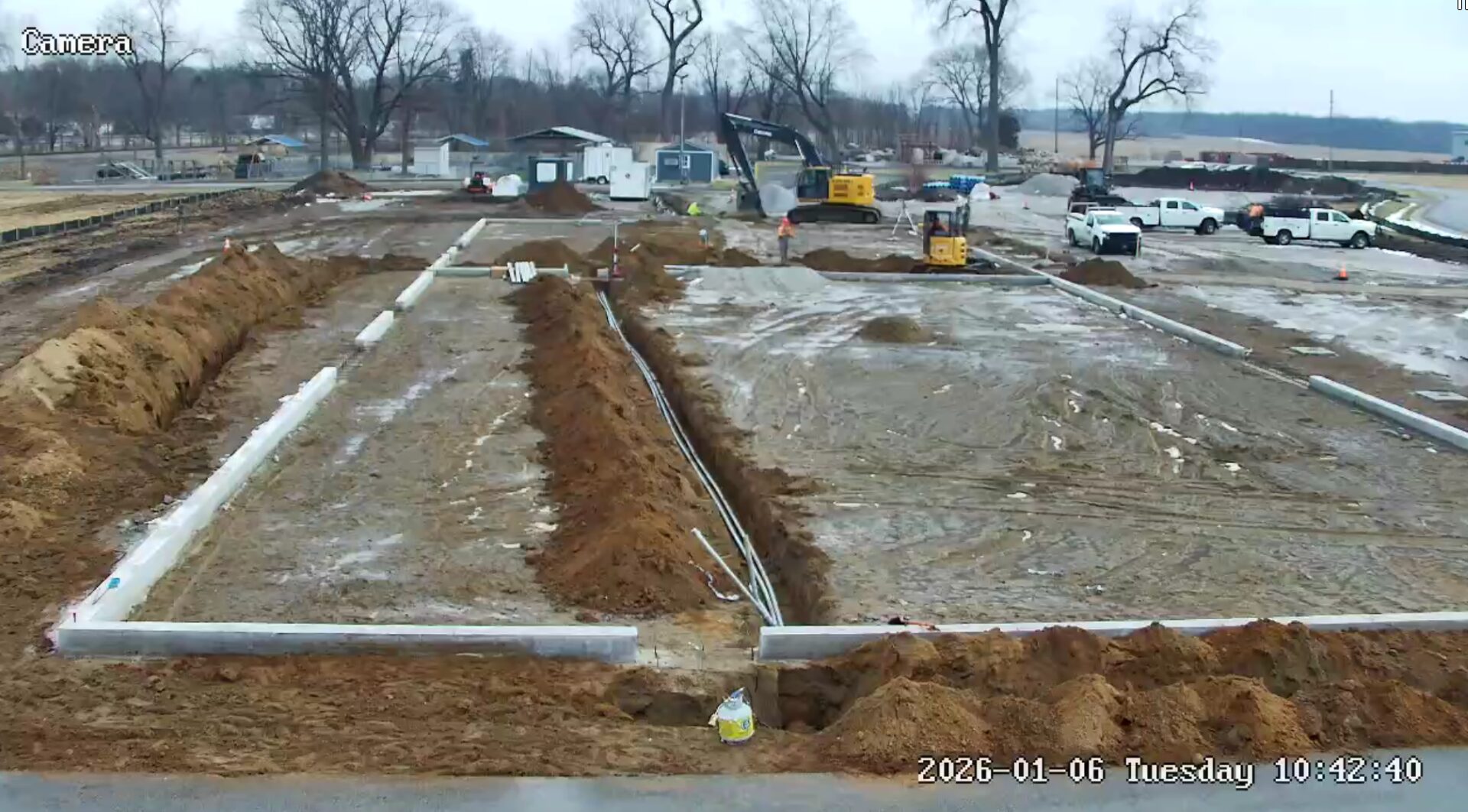

On Monday, ECE and Circle R started the installation of underground electrical conduits.  They finished the inside of the building and also around the perimeter of the building and backfilled to allow Cleary to have access.

Cleary Crews arrived on Friday to start getting organized to construct the building framing.

Week 6

The Carpenters have removed the concrete blankets and stripped the forms.  The Excavation crew has started to clean up the site to get ready for Cleary Building to start in early January on the building.  Cleary will likely start delivery of building materials during the first week of January.  The construction crews will get started soon after and we will get a firmer date after the holidays.

Temporary electric power is still being worked out.  The State Permit for the Building has been received.  The water agreement has been signed and forwarded to Valpo City Utilities (VCU) for approval.

Week 5

Since the last update, the carpenter crew did a good job working through the weather to get the finishing touches on the above ground footers and also pour the concrete for the footers.  The excavation crew also connected and installed the main storm drain line on the North Side of the building.

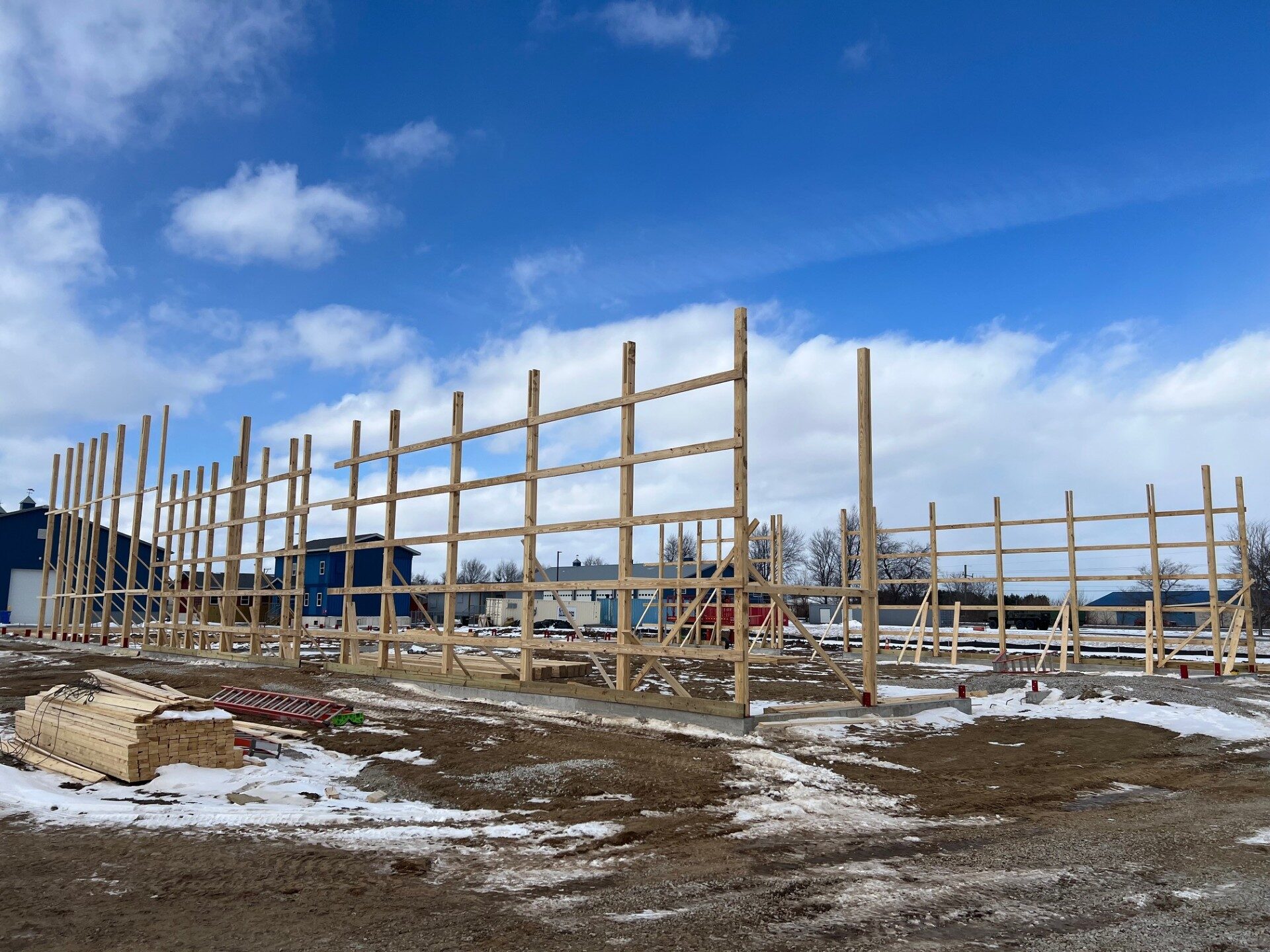

Week 2

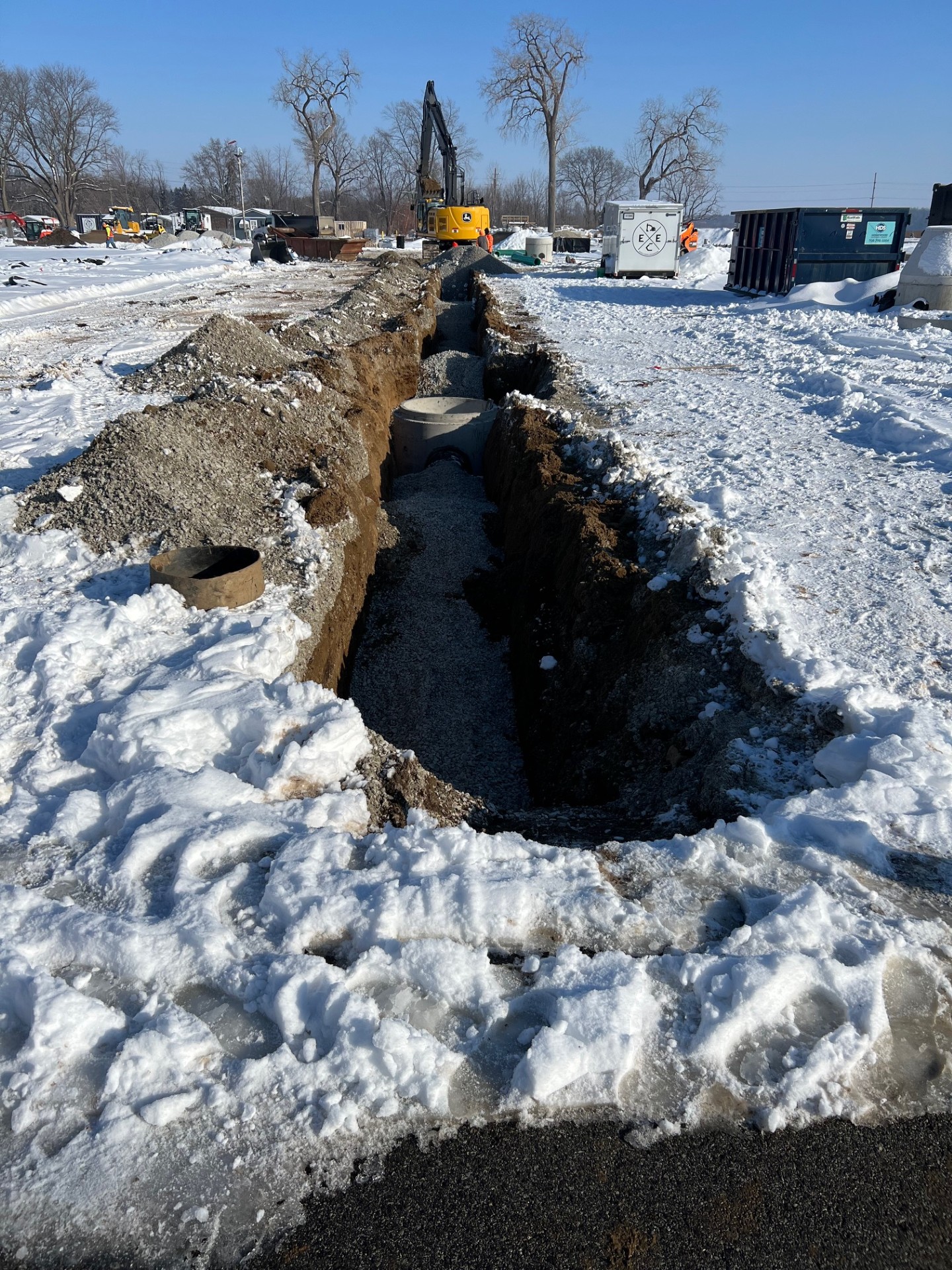

The excavation of the parking lot drain line has started.  When we built Heroes Hangout, we ensured the storm drain and fire hydrant line extended past the road on the East side of Heroes Hangout so that we would not impact trainings or cut asphalt for any future buildings.

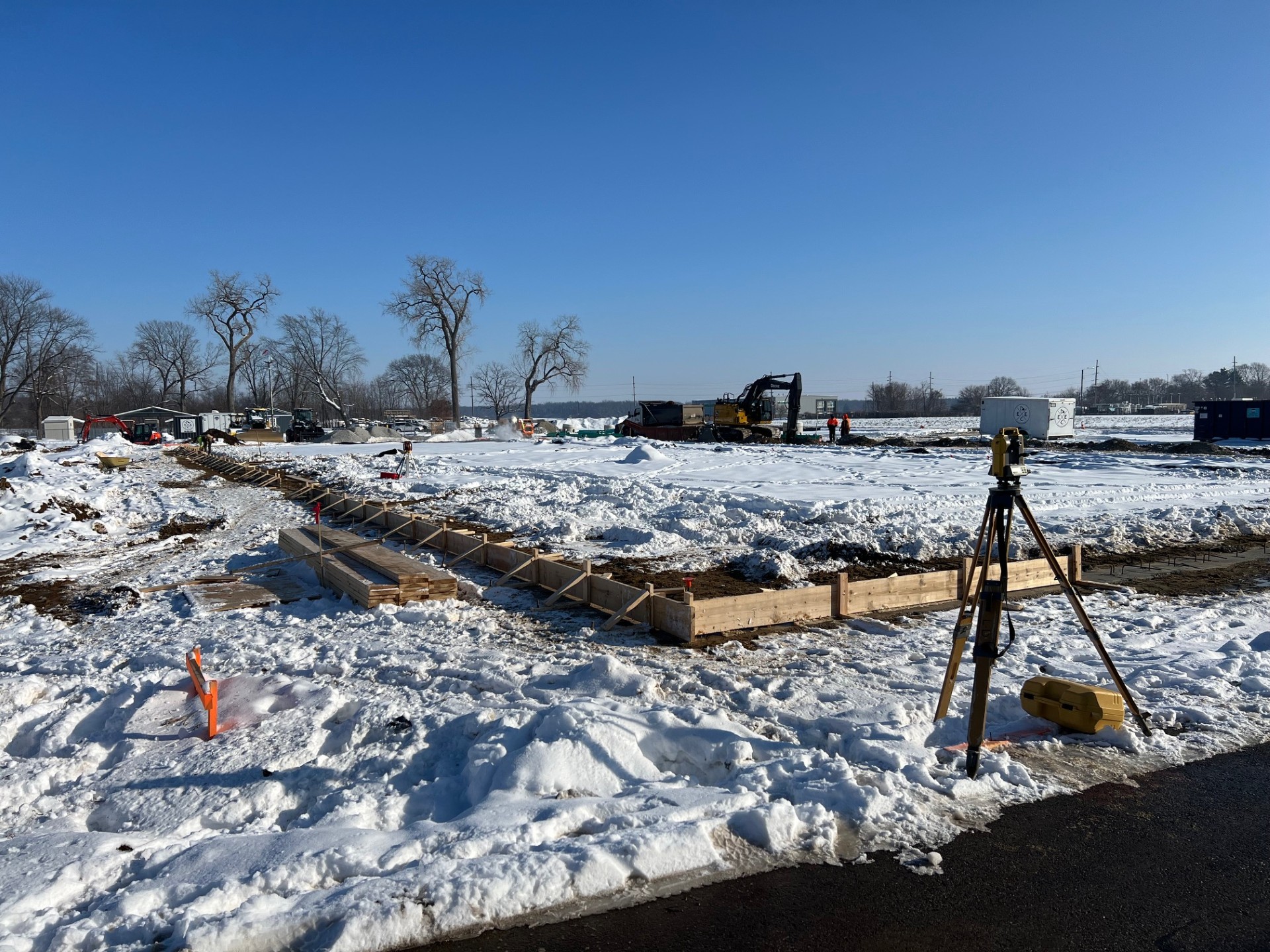

The Carpenters are building the forms for the finished foundation for the walls on top of the footers.  They are looking to pour about half of the finished foundation later this week with the rest to follow next week.  Something will look a bit odd later in the week when we will see a type of tent structure over the forms with propane heaters blowing into the tented forms.  The purpose is to heat up the footers so when the concrete is poured later in the week a good surface contact can be made between the footer concrete and the new concrete.  I'm told that the temperature of the footers needs to be about 40 degrees to make this happen.

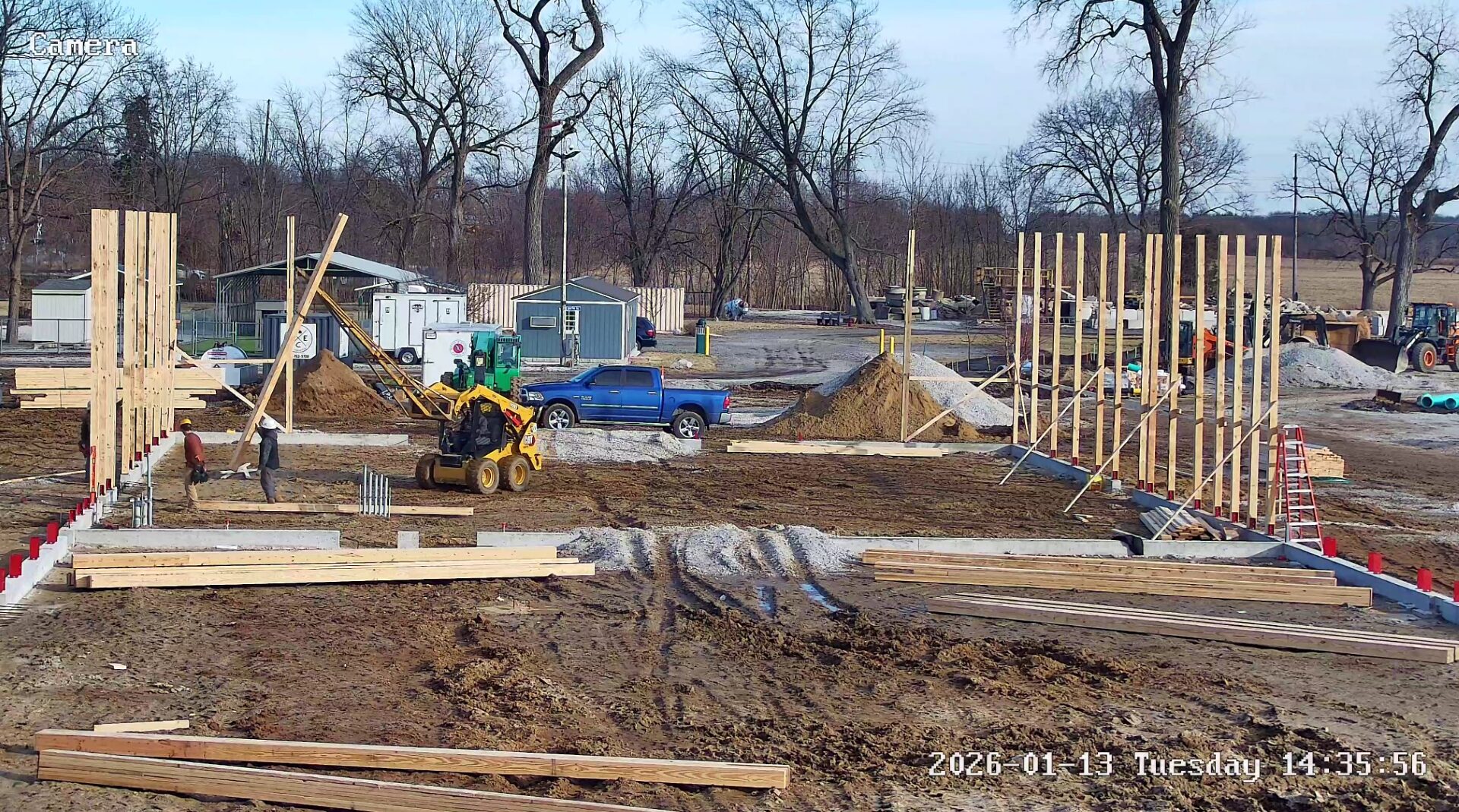

Week 1

Yesterday was the kickoff meeting lead by Larsen Daniels soon to start construction on the new building.  Today, Egolf Coates Excavation has started clearing the snow to allow for the silt fence to be installed by Modern Edge Landscaping.  Egolf Coates has also started on the construction entrance and once the silt fence is up will start removing the soil and bringing in fill.
